Mudon Al Ranim 7

مدن الرنيم 7
Latest DLD inspection photo of Mudon Al Ranim 7
Latest inspection · 2026-09-15 · DLD inspection
Planned handover2026-09-17
SourceDLD · daily

The road to keys — registry facts, our forecast

Registered start
2023-09-01
in the DLD registry
Today
100.0%
last inspected 2026-09-11
Pace forecast
Day 7 of 7
unlocks as daily tracking accrues
Planned handover
2026-09-17
developer's official date

Investor snapshot — estimated yield

5.8%estimated gross rental yield

1,608/sqft median sale price (this project)

93/sqft/yr median rent in Al Hebiah Sixth

Estimate: area-wide median rent ÷ this project’s median sale price, from Dubai Land Department records. Actual rent varies by unit, floor and finish.

How Mudon Al Ranim 7 compares

Similar off-plan projects in Al Hebiah Sixth — compare progress, handover and developer.

Ready to take the next step?

Talk to a verified agent about Mudon Al Ranim 7

Considering buying in Mudon Al Ranim 7? Register your interest and we’ll connect you with a RERA-licensed Dubai agent who can walk you through availability, payment plans and resale value — alongside the honest, registry-backed data you see on this page. No obligation.

or register your interest below

By submitting, you agree to be contacted about this project. We only introduce currently RERA-licensed agents.

Watch it rise — one frame per DLD inspection

Mudon Al Ranim 7 on 2023-06-14
2023-06-14 · 0.0% complete
1 / 10

Building & unit mix — from DLD project records

Floors
248
Total units
Buildings
UsageUnit typeUnits
Residential3 B/R150
Residential4 B/R98

Source: DLD project register — floors, buildings and the developer's registered unit mix.

Real sale prices 26 registered DLD sales since 2026-01-08

AED 1,608/sqft
Median sale price
26
Registered sales
26
Sales, last 12 months
Unit typeSalesMedian AED/sqftMedian price
3 B/R141,712AED 3.1M
4 B/R121,380AED 3.9M

Source: DLD registered sale transactions for this project.

Prices by unit size — vs the Al Hebiah Sixth average

BedsUnits soldSize rangeMedian priceAED/sqftArea avgPremium vs area
3 B/R141,8082,357 sqftAED 3.1M1,7121,825-6%
4 B/R122,5833,581 sqftAED 3.9M1,3801,491-7%

Median AED/sqft of DLD-registered sales in this project vs all sales in Al Hebiah Sixth for the same unit type. “Premium vs area” is how much more (or less) buyers pay here than the neighbourhood average.

Sale price history 310 sales, median AED/sqft by year

+11% median price growth from 2024 to 2026 · 100% of sales were off-plan

YearMedian AED/sqftSalesYear-on-yearSince launch
2024launch1,377258
20251,51829+10%+10%
20261,52823+1%+11%

Median AED/sqft of DLD-registered sales each year (years with 3+ sales); the earliest year on record approximates launch pricing. “Year-on-year” compares each year to the one before it, “since launch” to the first year. Source: Dubai Land Department transaction records.

Available layouts — check current availability & price

Layouts registered in Mudon Al Ranim 7, grouped by size. We’ll confirm current availability, floor and price with a RERA-licensed agent — we don’t hold live developer inventory, so these are representative configurations, not a live unit list.

BedsSizeTypical priceAED/sqftRegistered
3 B/R1,808 sqftAED 3.5M1,9224
3 B/R1,822 sqftAED 3.1M1,7153
3 B/R1,850 sqftAED 3.3M1,7922
3 B/R1,883 sqftAED 3.1M1,6351
3 B/R1,905 sqftAED 3.0M1,5872
3 B/R1,962 sqftAED 3.1M1,5801
3 B/R2,357 sqftAED 3.5M1,4761
4 B/R2,583 sqftAED 3.9M1,4905
4 B/R2,609 sqftAED 4.4M1,6861
4 B/R2,736 sqftAED 3.9M1,4251
4 B/R2,852 sqftAED 3.6M1,2621
4 B/R3,215 sqftAED 4.0M1,2441
4 B/R3,500 sqftAED 4.0M1,1472
4 B/R3,581 sqftAED 4.5M1,2431

Recent registered sales — individual DLD transactions, newest first

DateBedsSizePriceAED/sqftType
2026-09-183 B/R1,883 sqftAED 3.1M1,635Off-plan
2026-08-243 B/R1,822 sqftAED 3.1M1,715Off-plan
2026-08-143 B/R1,808 sqftAED 3.5M1,908Off-plan
2026-07-103 B/R1,846 sqftAED 3.5M1,885Off-plan
2026-07-074 B/R2,583 sqftAED 3.9M1,490Off-plan
2026-07-024 B/R2,583 sqftAED 3.5M1,355Off-plan
2026-06-223 B/R1,898 sqftAED 2.9M1,528Off-plan
2026-06-163 B/R1,815 sqftAED 3.1M1,708Off-plan
2026-06-114 B/R3,497 sqftAED 4.1M1,167Off-plan
2026-06-103 B/R1,808 sqftAED 3.6M1,991Off-plan
2026-06-104 B/R2,584 sqftAED 3.6M1,405Off-plan
2026-06-023 B/R1,912 sqftAED 3.1M1,647Off-plan
2026-05-214 B/R3,215 sqftAED 4.0M1,244Off-plan
2026-05-213 B/R1,962 sqftAED 3.1M1,580Off-plan
2026-04-283 B/R1,808 sqftAED 3.5M1,935Off-plan
2026-04-144 B/R3,581 sqftAED 4.5M1,243Off-plan
2026-03-103 B/R1,853 sqftAED 3.1M1,700Off-plan
2026-02-174 B/R2,583 sqftAED 3.9M1,490Off-plan
2026-02-174 B/R2,583 sqftAED 4.4M1,703Off-plan
2026-02-104 B/R2,609 sqftAED 4.4M1,686Off-plan
2026-02-044 B/R3,502 sqftAED 4.0M1,128Off-plan
2026-02-033 B/R1,834 sqftAED 3.3M1,773Off-plan
2026-01-283 B/R2,357 sqftAED 3.5M1,476Off-plan
2026-01-283 B/R1,808 sqftAED 3.1M1,724Off-plan
2026-01-144 B/R2,852 sqftAED 3.6M1,262Off-plan
2026-01-084 B/R2,736 sqftAED 3.9M1,425Off-plan

Source: DLD registered sale transactions. Floor and unit numbers aren’t published in the public transaction feed, so they’re not shown.

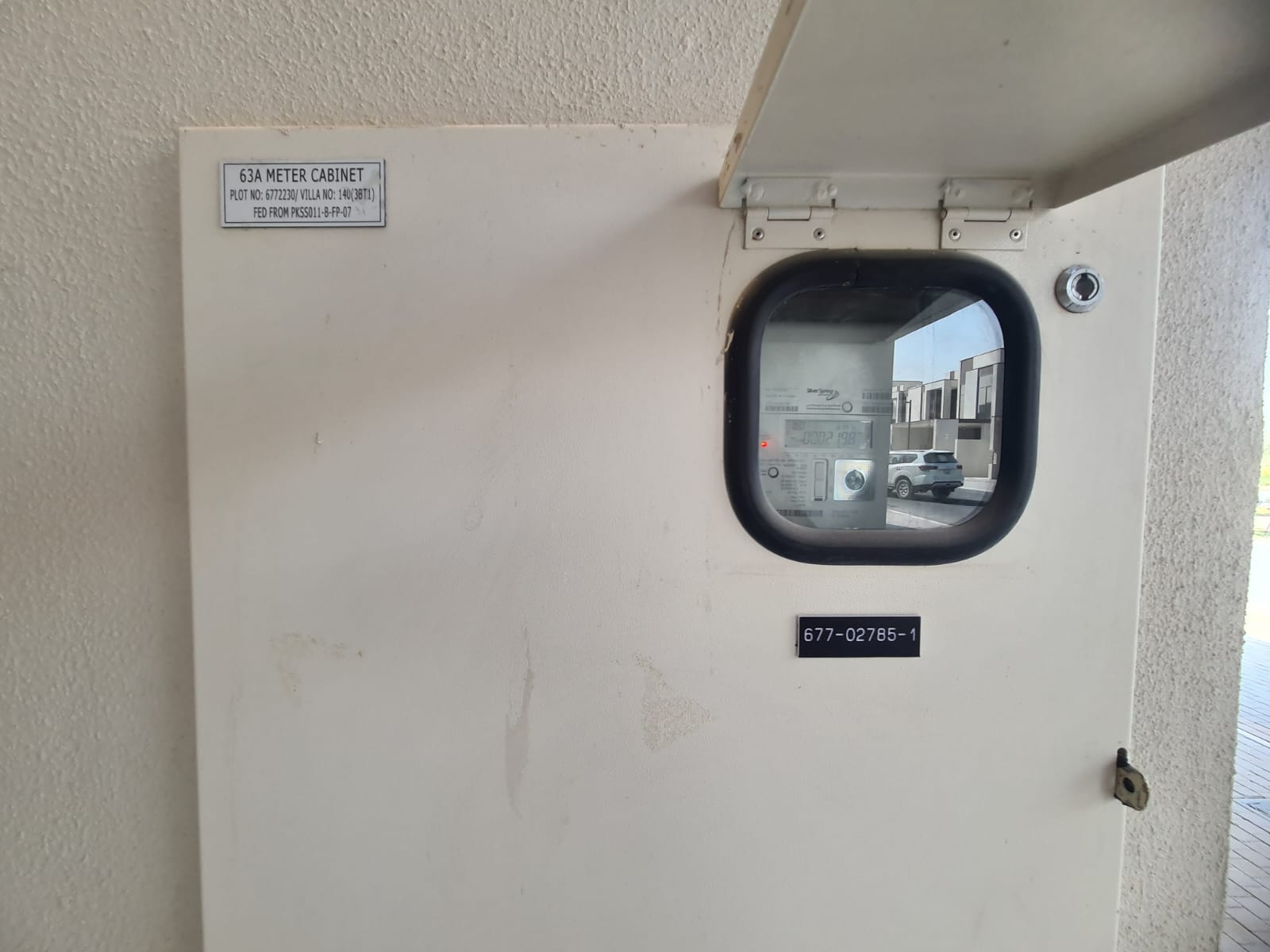

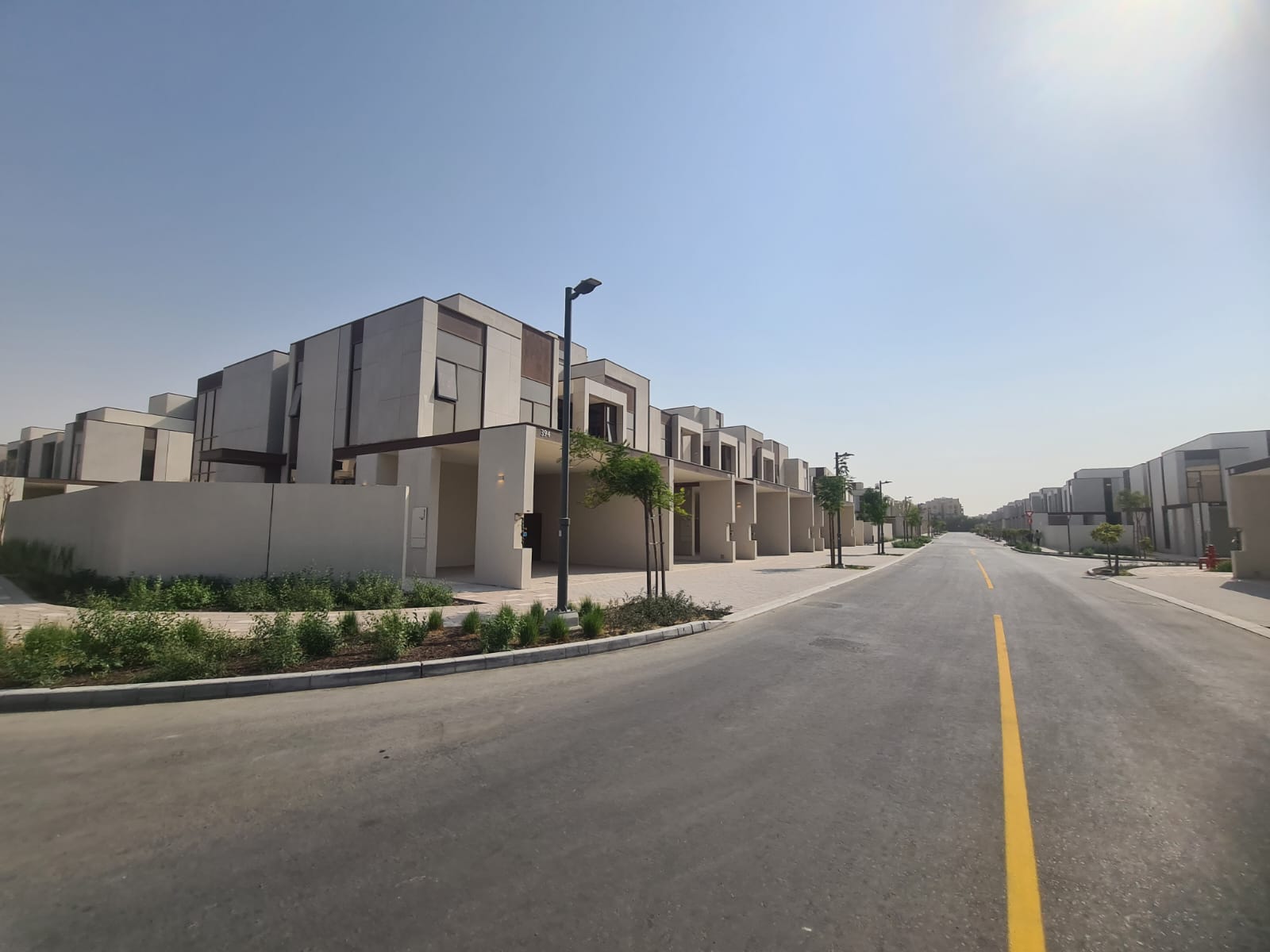

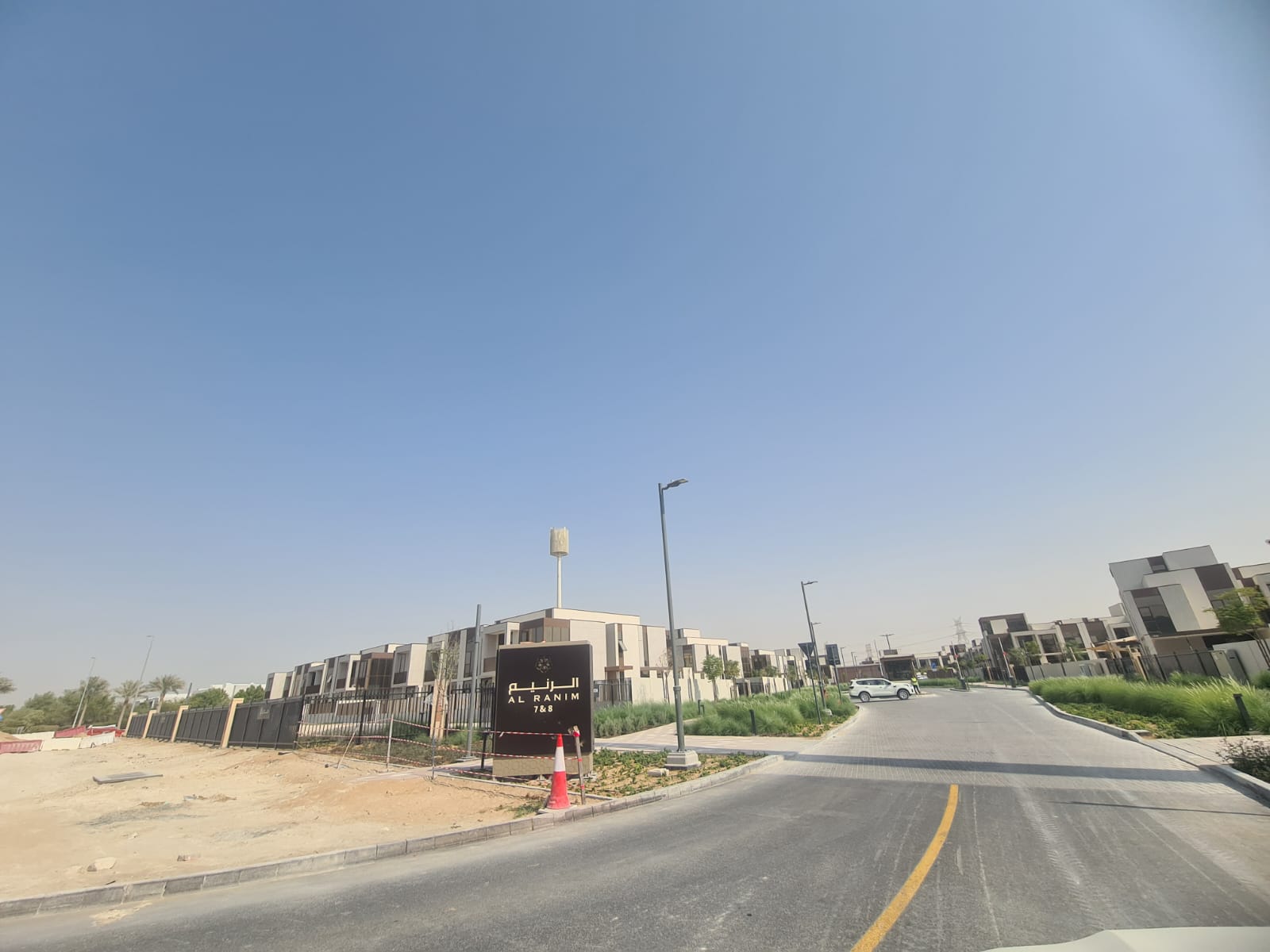

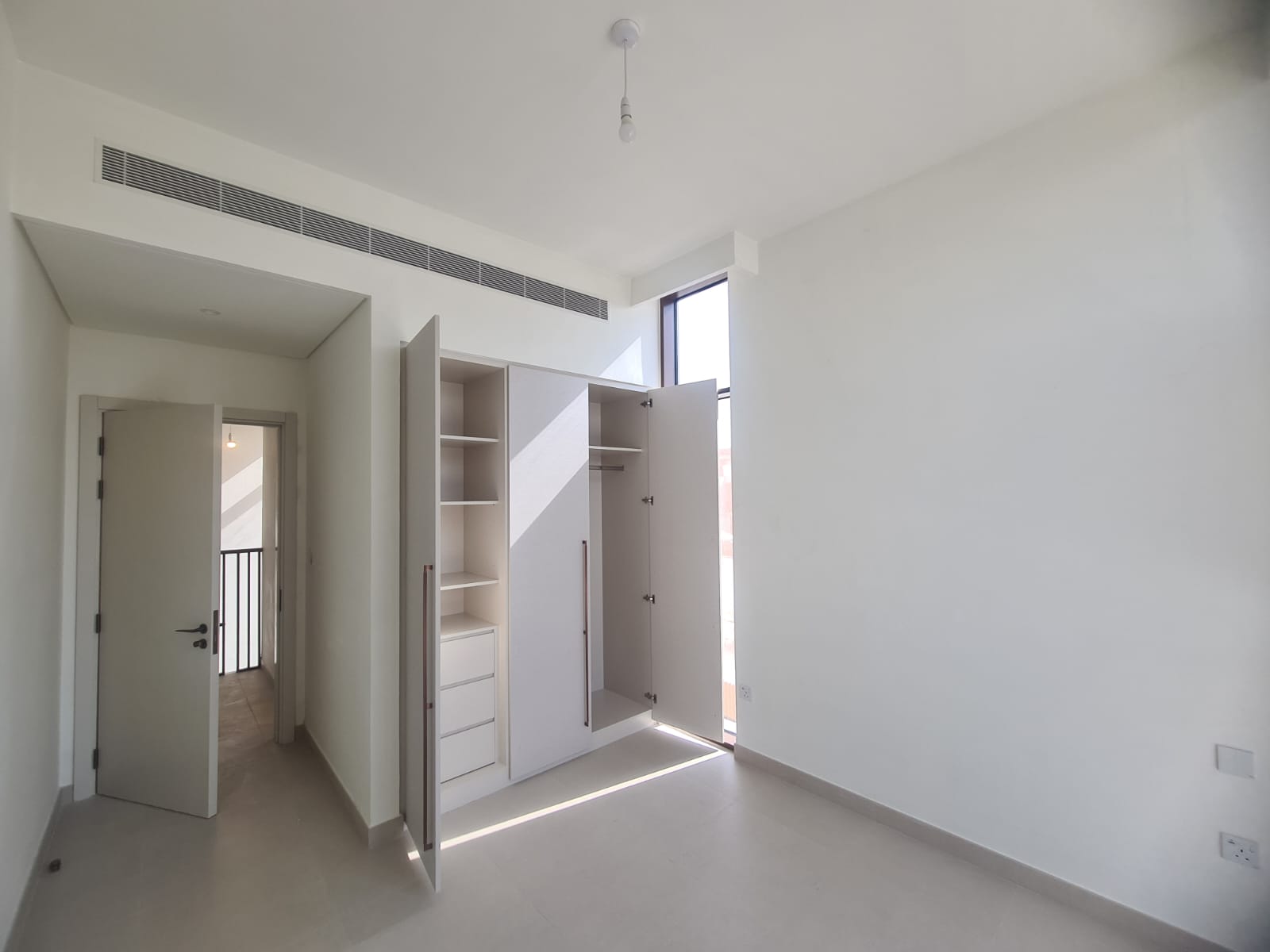

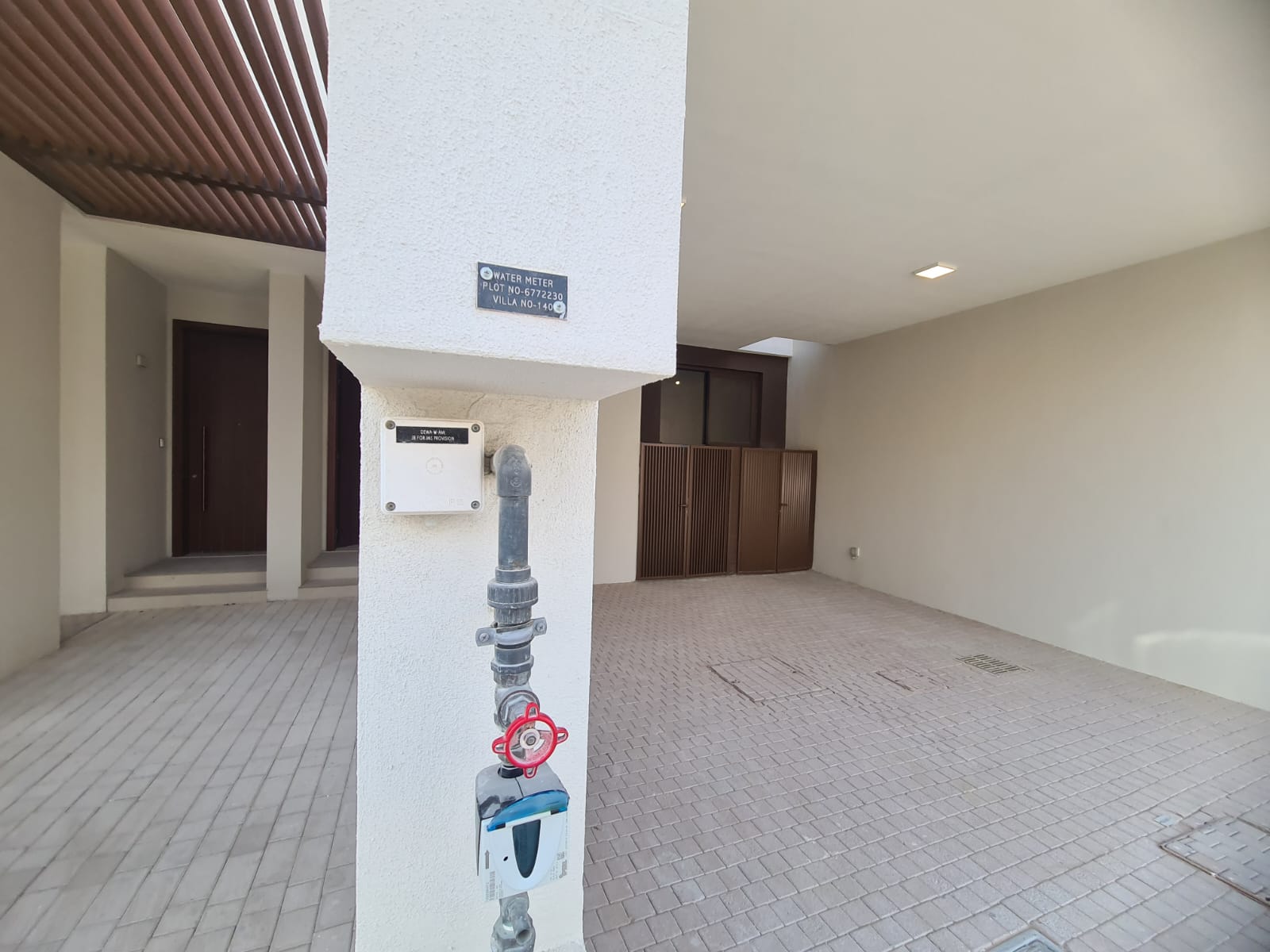

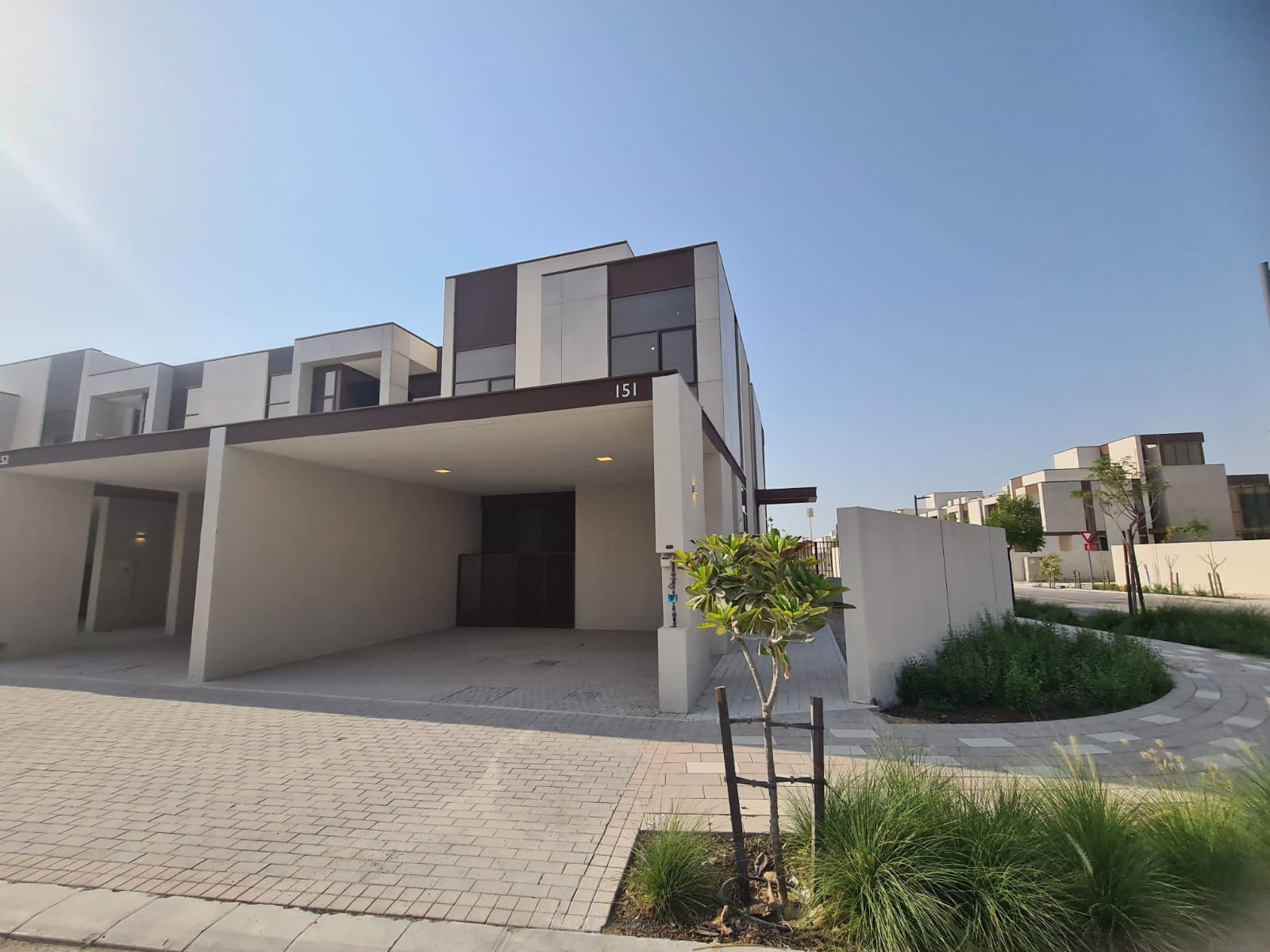

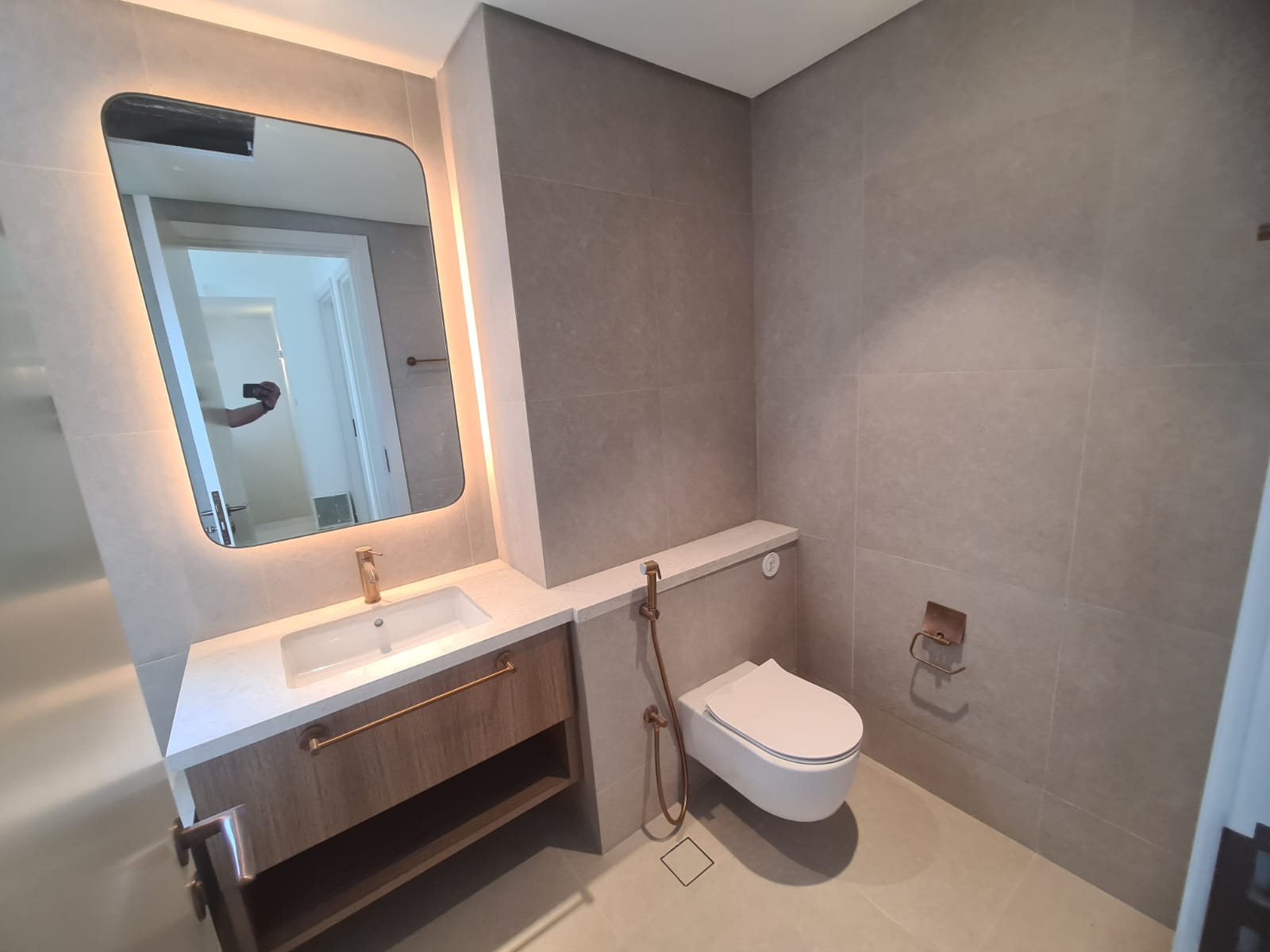

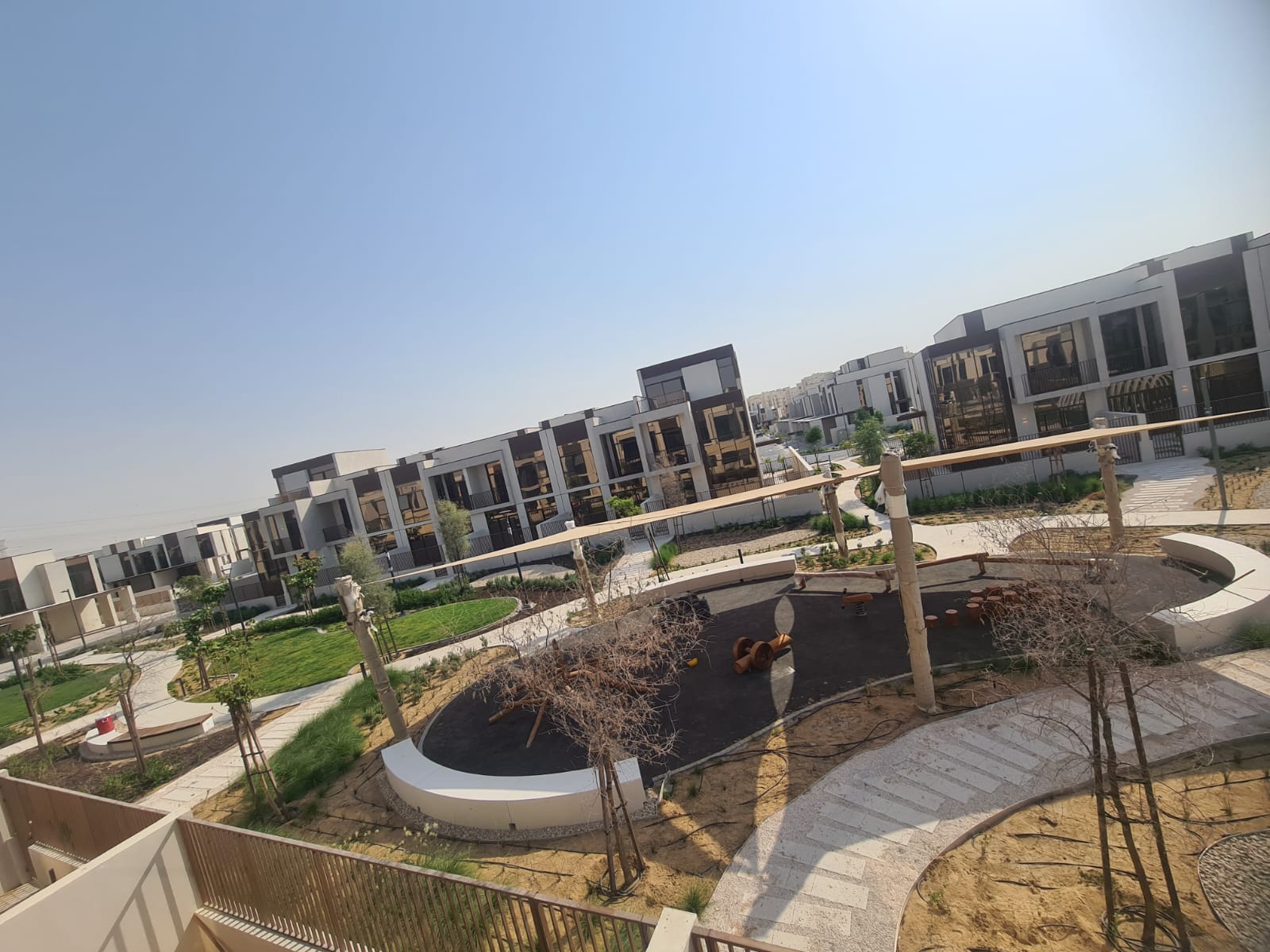

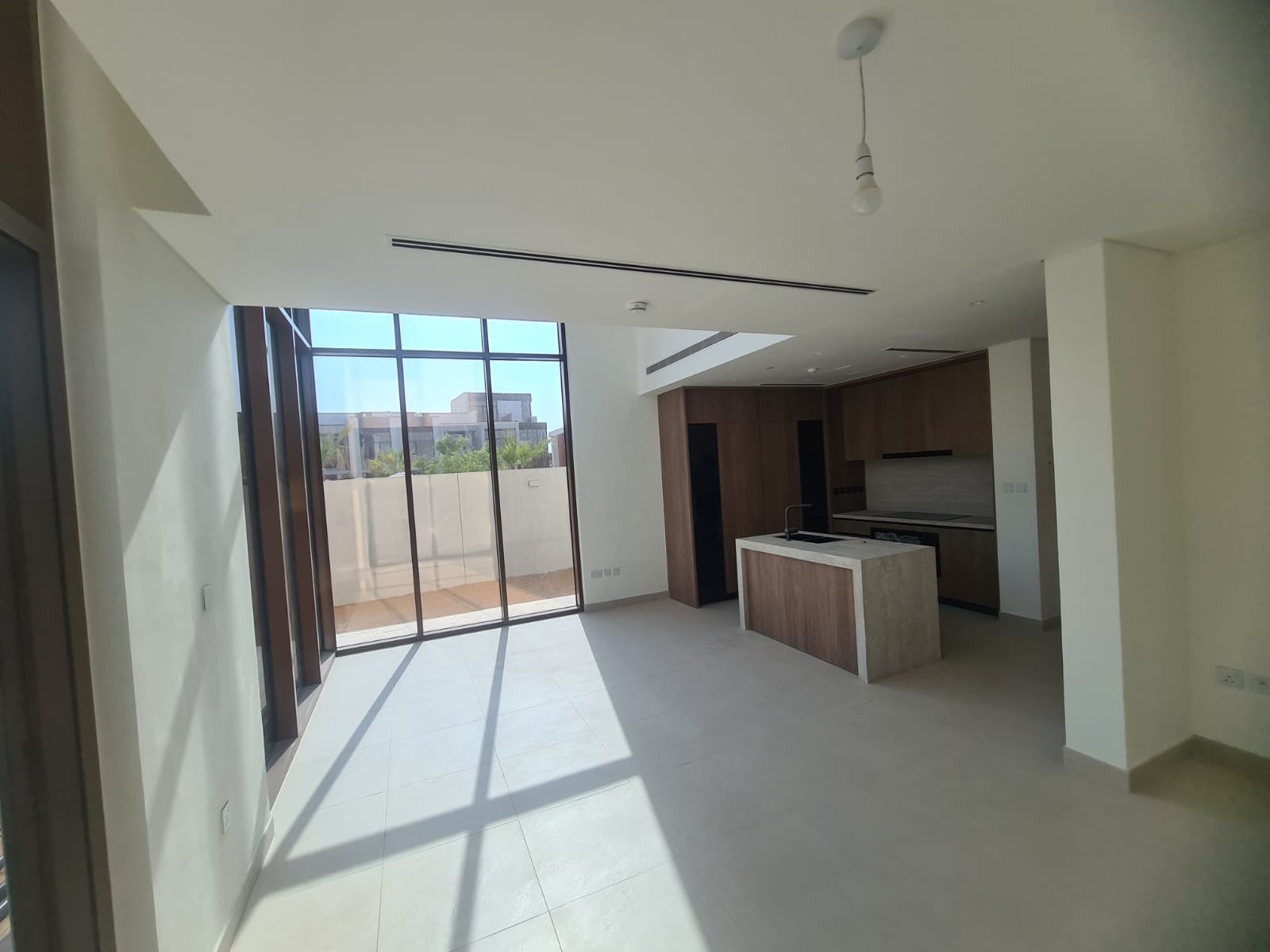

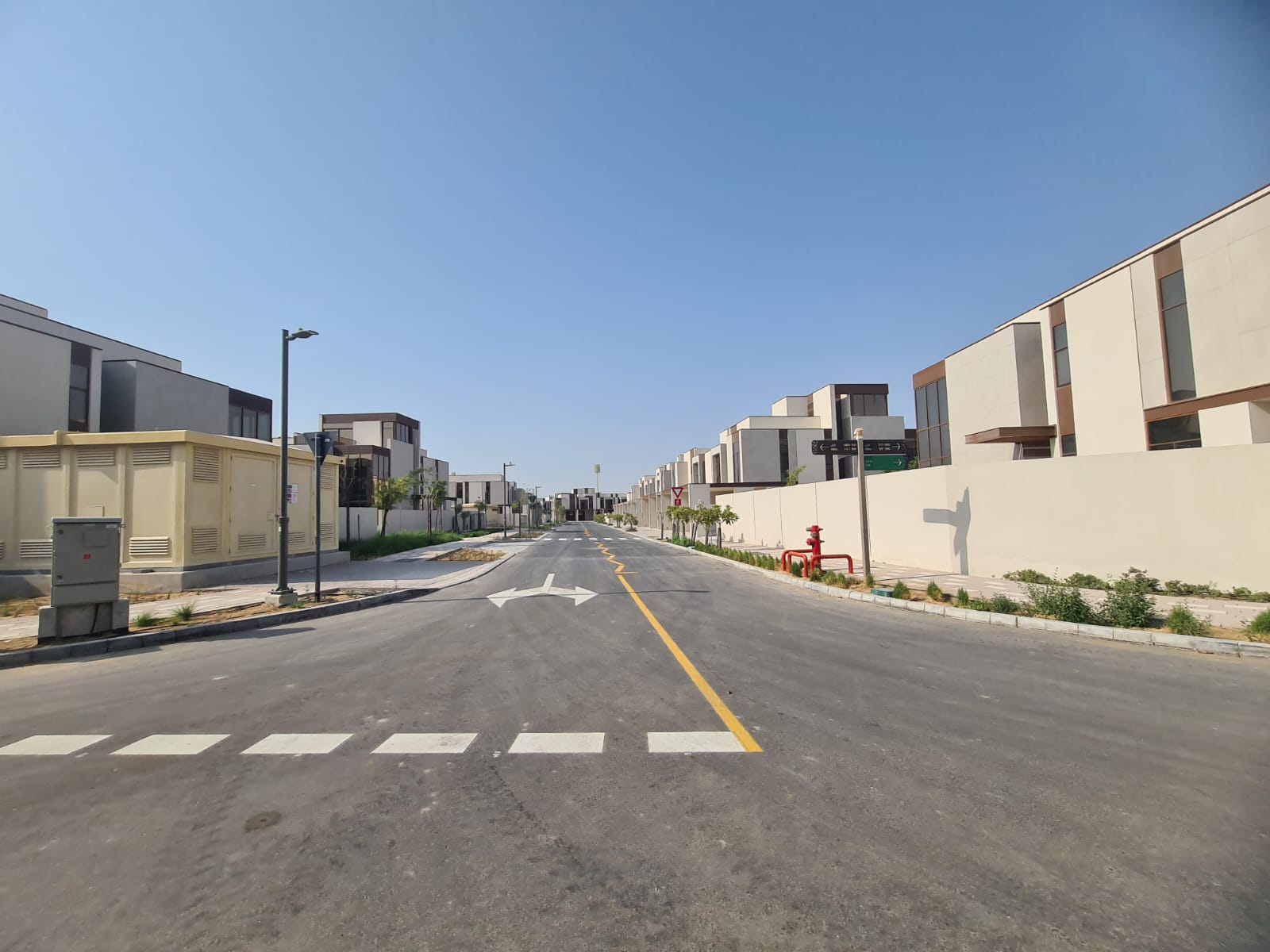

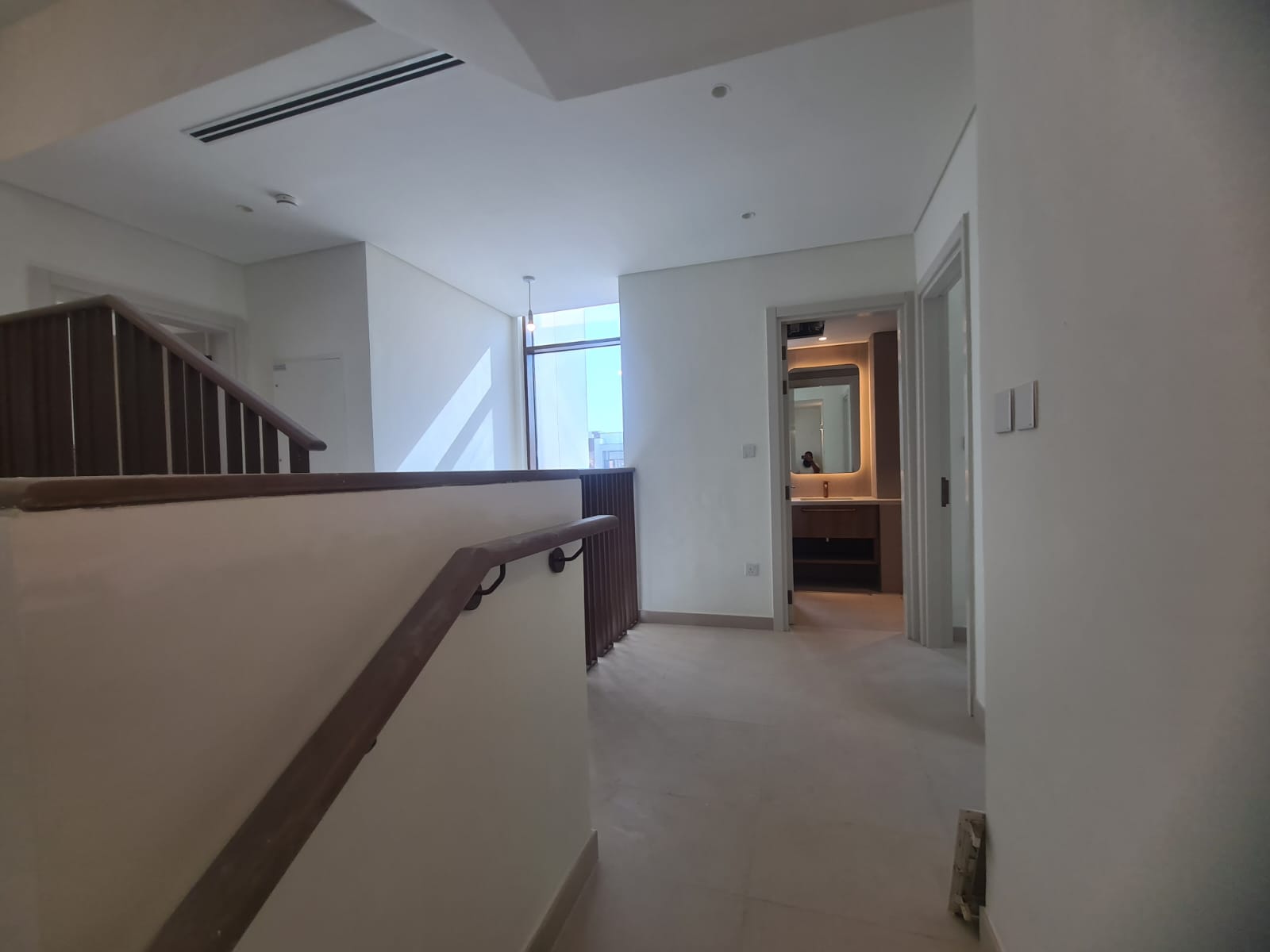

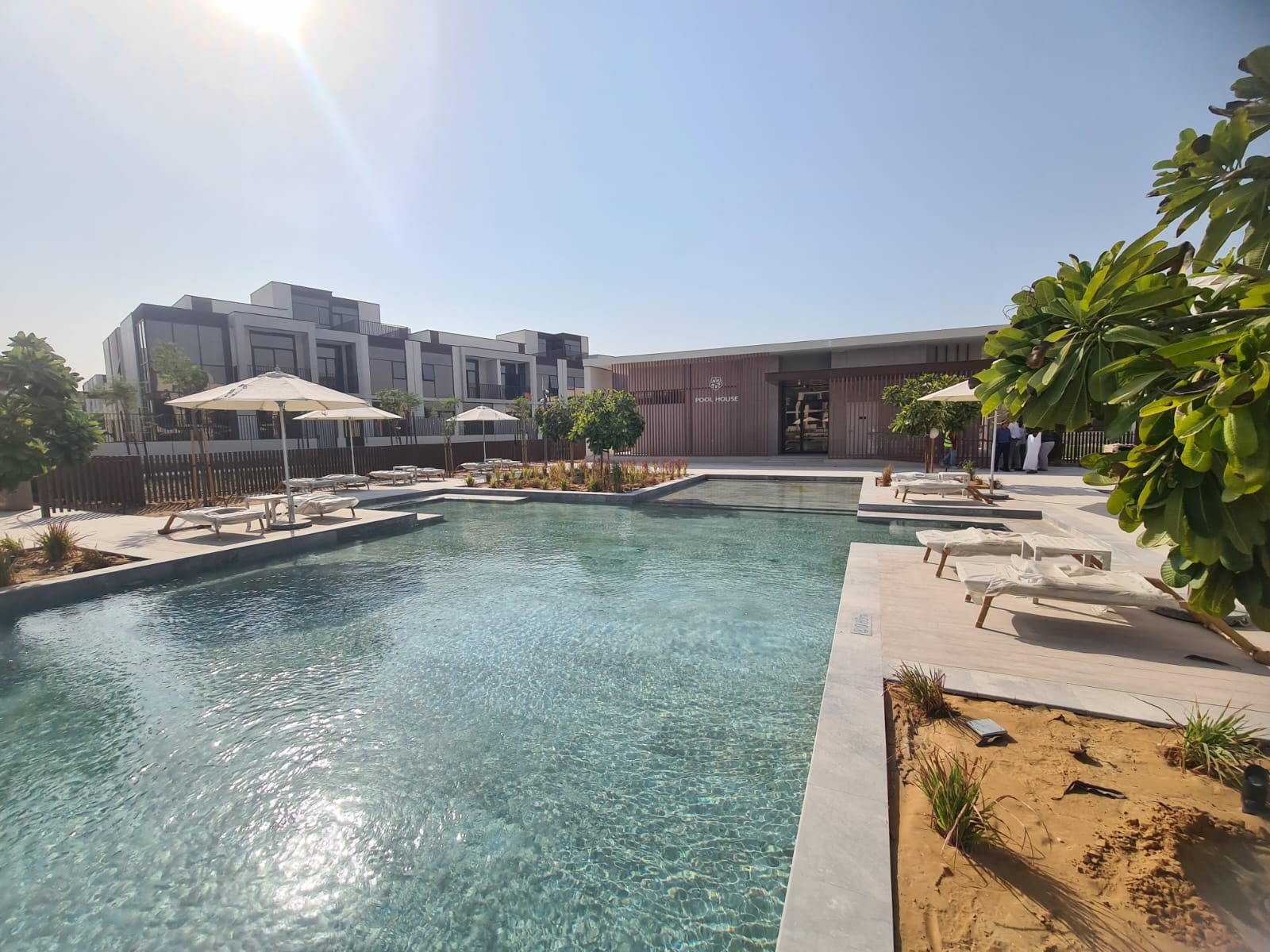

Construction photos — official DLD inspection uploads, newest first

Project facts

Developer
MDN REAL ESTATE L.L.C
Area
Al Hebiah Sixth
Master project
Project type
Normal
Start date
2023-09-01
Planned handover
2026-09-17
Last inspection
2026-09-11
Project value
AED 283.9M
Units
0
Villas
248
Buildings
0
DLD project number
2699

Registration & escrow — verify before you pay anyone

DLD / RERA project no.
2699
Registered with DLD
2023-06-19
Regulator
Dubai Development Authority (DDA)
Escrow account no.
001582334544401

Under Law 8 of 2007, off-plan payments for this project belong only in the escrow account above — a developer or agent directing your money anywhere else is a serious red flag. How escrow protects you →

Location — official site coordinates from DLD inspection records

Loading map…

Al Hebiah Sixth · See every project on the construction map →

Mudon Al Ranim 7: frequently asked questions — answers update daily from registry data

When will Mudon Al Ranim 7 be handed over?
The developer's planned handover for Mudon Al Ranim 7 is 2026-09-17; construction is currently 100% complete. Planned dates can move — track the project to be alerted the moment the official date changes.
How far along is construction on Mudon Al Ranim 7?
Mudon Al Ranim 7 is 100.0% complete according to the Dubai Land Department's inspection of 2026-09-11. Progress moved up 8.0 percentage points at the latest inspection.
Who is the developer of Mudon Al Ranim 7, and do they deliver on time?
Mudon Al Ranim 7 is developed by MDN REAL ESTATE L.L.C.
What are real sale prices in Mudon Al Ranim 7?
Registered DLD sales in Mudon Al Ranim 7 show a median of AED 1,608/sqft across 26 transactions since 2026-01-08. These are actual registered sales, not asking prices — the full breakdown is on this page.
Where is Mudon Al Ranim 7 located?
Mudon Al Ranim 7 is located in Al Hebiah Sixth, Dubai. See every project in the area, plus prices and rents, on the area page.
How many homes are in Mudon Al Ranim 7?
Mudon Al Ranim 7 comprises 248 villas (normal), per the DLD registry.
Can I see real construction photos of Mudon Al Ranim 7?
Yes — this page carries 78 official construction photos taken during Dubai Land Department inspections, newest from 2026-09-15, plus a time-lapse of the build. These are government inspection uploads, not marketing renders.
Is my money safe if I buy in Mudon Al Ranim 7?
Payments for registered Dubai off-plan projects go into a project-specific escrow account under Law No. 8 of 2007; the developer can only draw funds against certified construction milestones.
Where should payments for Mudon Al Ranim 7 go?
Only into the project's DLD-registered escrow account (no. 001582334544401). Under Law 8 of 2007 every off-plan payment must go to this account, where the developer can only draw funds as construction milestones are certified. Anyone directing payments elsewhere is a serious warning sign.
How do I get alerts when something changes on Mudon Al Ranim 7?
Use the free Track this project form on this page. We check the official registry every day and email you the moment Mudon Al Ranim 7's progress, status, or planned handover date changes.

Progress history — one row per official DLD snapshot

Snapshot dateStatusCompletePlanned handover
2026-08-04ACTIVE92.0%2026-09-30
2026-08-05ACTIVE92.0%2026-09-30
2026-08-06ACTIVE92.0%2026-09-30
2026-08-08ACTIVE92.0%2026-09-30
2026-08-09ACTIVE92.0%2026-09-30
2026-08-10ACTIVE92.0%2026-09-30
2026-08-11ACTIVE92.0%2026-09-30
2026-08-12ACTIVE92.0%2026-09-30
2026-08-13ACTIVE92.0%2026-09-30
2026-08-14ACTIVE92.0%2026-09-30
2026-08-15ACTIVE92.0%2026-09-30
2026-08-16ACTIVE92.0%2026-09-30
2026-08-17ACTIVE92.0%2026-09-30
2026-08-18ACTIVE92.0%2026-09-30
2026-08-19ACTIVE92.0%2026-09-30
2026-08-20ACTIVE92.0%2026-09-30
2026-08-21ACTIVE92.0%2026-09-30
2026-08-22ACTIVE92.0%2026-09-30
2026-08-23ACTIVE92.0%2026-09-30
2026-08-24ACTIVE92.0%2026-09-30
2026-08-25ACTIVE92.0%2026-09-30
2026-08-26ACTIVE92.0%2026-09-30
2026-08-27ACTIVE92.0%2026-09-30
2026-08-28ACTIVE92.0%2026-09-30
2026-08-29ACTIVE92.0%2026-09-30
2026-08-30ACTIVE92.0%2026-09-30
2026-08-31ACTIVE92.0%2026-09-30
2026-09-01ACTIVE92.0%2026-09-30
2026-09-02ACTIVE92.0%2026-09-30
2026-09-03ACTIVE92.0%2026-09-30
2026-09-04ACTIVE92.0%2026-09-30
2026-09-05ACTIVE92.0%2026-09-30
2026-09-06ACTIVE92.0%2026-09-30
2026-09-07ACTIVE92.0%2026-09-30
2026-09-08ACTIVE92.0%2026-09-30
2026-09-09ACTIVE92.0%2026-09-30
2026-09-10ACTIVE92.0%2026-09-30
2026-09-11ACTIVE92.0%2026-09-30
2026-09-12ACTIVE92.0%2026-09-30
2026-09-13ACTIVE92.0%2026-09-30
2026-09-14ACTIVE92.0%2026-09-30
2026-09-15ACTIVE92.0%2026-09-30
2026-09-16ACTIVE92.0%2026-09-30
2026-09-17ACTIVE92.0%2026-09-30
2026-09-18FINISHED100.0%2026-09-17
2026-09-19FINISHED100.0%2026-09-17
2026-09-20FINISHED100.0%2026-09-17

Change events

DetectedEventChange
2026-09-18HANDOVER_EARLY2026-09-302026-09-17
2026-09-18STATUS_CHANGEACTIVEFINISHED
2026-09-18PROGRESS91.95100.00
Don't check back — we'll tell you.Progress moves, dates slip, statuses change. One email the moment it happens.
Track Mudon Al Ranim 7
