The road to keys — registry facts, our forecast
Investor snapshot — estimated yield
4,119/sqft median sale price (this project)
86/sqft/yr median rent in Al Safouh First
Estimate: area-wide median rent ÷ this project’s median sale price, from Dubai Land Department records. Actual rent varies by unit, floor and finish.
How Shahrukhz by Danube compares
Similar off-plan projects in Al Safouh First — compare progress, handover and developer.
Track this project
Get an email the moment DLD reports a change — construction progress, a status change, or a handover date that moves.
One click. Creates your free account — no password, ever.
Talk to a verified agent about Shahrukhz by Danube
Considering buying in Shahrukhz by Danube? Register your interest and we’ll connect you with a RERA-licensed Dubai agent who can walk you through availability, payment plans and resale value — alongside the honest, registry-backed data you see on this page. No obligation.
Watch it rise — one frame per DLD inspection
.jpeg)
Building & unit mix — from DLD project records
| Usage | Unit type | Units |
|---|---|---|
| Commercial | Unspecified | 662 |
Source: DLD project register — floors, buildings and the developer's registered unit mix.
Real sale prices — 535 registered DLD sales since 2026-01-19
| Unit type | Sales | Median AED/sqft | Median price |
|---|---|---|---|
| NA | 535 | 4,119 | AED 2.3M |
Source: DLD registered sale transactions for this project.
Prices by unit size — vs the Al Safouh First average
| Beds | Units sold | Size range | Median price | AED/sqft | Area avg | Premium vs area |
|---|---|---|---|---|---|---|
| NA | 535 | 454–12,891 sqft | AED 2.3M | 4,119 | — | — |
Median AED/sqft of DLD-registered sales in this project vs all sales in Al Safouh First for the same unit type. “Premium vs area” is how much more (or less) buyers pay here than the neighbourhood average.
Available layouts — check current availability & price
Layouts registered in Shahrukhz by Danube, grouped by size. We’ll confirm current availability, floor and price with a RERA-licensed agent — we don’t hold live developer inventory, so these are representative configurations, not a live unit list.
| Beds | Size | Typical price | AED/sqft | Registered | |
|---|---|---|---|---|---|
| NA | 454 sqft | AED 1.8M | 3,984 | 11 | |
| NA | 466 sqft | AED 2.0M | 4,260 | 220 | |
| NA | 495 sqft | AED 2.0M | 3,996 | 16 | |
| NA | 524 sqft | AED 2.1M | 3,957 | 12 | |
| NA | 562 sqft | AED 2.3M | 4,095 | 18 | |
| NA | 575 sqft | AED 2.3M | 4,054 | 84 | |
| NA | 596 sqft | AED 2.3M | 3,817 | 5 | |
| NA | 628 sqft | AED 2.6M | 4,144 | 4 | |
| NA | 655 sqft | AED 2.5M | 3,841 | 32 | |
| NA | 684 sqft | AED 2.8M | 4,086 | 2 | |
| NA | 695 sqft | AED 2.8M | 4,021 | 2 | |
| NA | 734 sqft | AED 3.2M | 4,317 | 10 | |
| NA | 760 sqft | AED 2.9M | 3,754 | 42 | |
| NA | 776 sqft | AED 3.2M | 4,176 | 1 |
Recent registered sales — individual DLD transactions, newest first
| Date | Beds | Size | Price | AED/sqft | Type |
|---|---|---|---|---|---|
| 2026-09-16 | NA | 468 sqft | AED 2.1M | 4,596 | Off-plan |
| 2026-09-12 | NA | 575 sqft | AED 2.6M | 4,445 | Off-plan |
| 2026-09-10 | NA | 465 sqft | AED 2.5M | 5,370 | Off-plan |
| 2026-09-01 | NA | 655 sqft | AED 2.5M | 3,887 | Off-plan |
| 2026-08-27 | NA | 760 sqft | AED 3.5M | 4,650 | Off-plan |
| 2026-08-20 | NA | 494 sqft | AED 2.1M | 4,338 | Off-plan |
| 2026-08-18 | NA | 468 sqft | AED 2.1M | 4,570 | Off-plan |
| 2026-08-18 | NA | 465 sqft | AED 2.1M | 4,515 | Off-plan |
| 2026-08-11 | NA | 468 sqft | AED 2.6M | 5,635 | Off-plan |
| 2026-08-07 | NA | 465 sqft | AED 2.1M | 4,536 | Off-plan |
| 2026-08-06 | NA | 655 sqft | AED 2.4M | 3,720 | Off-plan |
| 2026-08-06 | NA | 468 sqft | AED 2.1M | 4,570 | Off-plan |
| 2026-08-06 | NA | 466 sqft | AED 2.1M | 4,535 | Off-plan |
| 2026-08-04 | NA | 655 sqft | AED 2.6M | 3,985 | Off-plan |
| 2026-07-29 | NA | 468 sqft | AED 2.1M | 4,450 | Off-plan |
| 2026-07-29 | NA | 466 sqft | AED 2.0M | 4,262 | Off-plan |
| 2026-07-28 | NA | 465 sqft | AED 2.2M | 4,763 | Off-plan |
| 2026-07-27 | NA | 468 sqft | AED 2.1M | 4,570 | Off-plan |
| 2026-07-25 | NA | 575 sqft | AED 2.6M | 4,454 | Off-plan |
| 2026-07-23 | NA | 790 sqft | AED 3.2M | 4,050 | Off-plan |
| 2026-07-20 | NA | 468 sqft | AED 2.0M | 4,278 | Off-plan |
| 2026-07-20 | NA | 586 sqft | AED 2.5M | 4,282 | Off-plan |
| 2026-07-15 | NA | 524 sqft | AED 2.0M | 3,829 | Off-plan |
| 2026-07-15 | NA | 466 sqft | AED 2.1M | 4,449 | Off-plan |
| 2026-07-15 | NA | 466 sqft | AED 2.0M | 4,262 | Off-plan |
| 2026-07-09 | NA | 931 sqft | AED 3.6M | 3,918 | Off-plan |
| 2026-07-08 | NA | 466 sqft | AED 2.2M | 4,678 | Off-plan |
| 2026-07-07 | NA | 468 sqft | AED 2.0M | 4,336 | Off-plan |
| 2026-07-06 | NA | 468 sqft | AED 2.0M | 4,329 | Off-plan |
| 2026-07-01 | NA | 3,350 sqft | AED 15.2M | 4,531 | Off-plan |
| 2026-06-25 | NA | 466 sqft | AED 2.2M | 4,743 | Off-plan |
| 2026-06-25 | NA | 734 sqft | AED 3.4M | 4,582 | Off-plan |
| 2026-06-24 | NA | 466 sqft | AED 2.2M | 4,743 | Off-plan |
| 2026-06-23 | NA | 468 sqft | AED 2.1M | 4,492 | Off-plan |
| 2026-06-19 | NA | 466 sqft | AED 2.3M | 5,046 | Off-plan |
| 2026-06-19 | NA | 655 sqft | AED 2.5M | 3,763 | Off-plan |
| 2026-06-19 | NA | 563 sqft | AED 3.1M | 5,431 | Off-plan |
| 2026-06-19 | NA | 981 sqft | AED 3.9M | 3,936 | Off-plan |
| 2026-06-19 | NA | 466 sqft | AED 1.9M | 4,075 | Off-plan |
| 2026-06-19 | NA | 454 sqft | AED 2.2M | 4,778 | Off-plan |
Source: DLD registered sale transactions. Floor and unit numbers aren’t published in the public transaction feed, so they’re not shown.

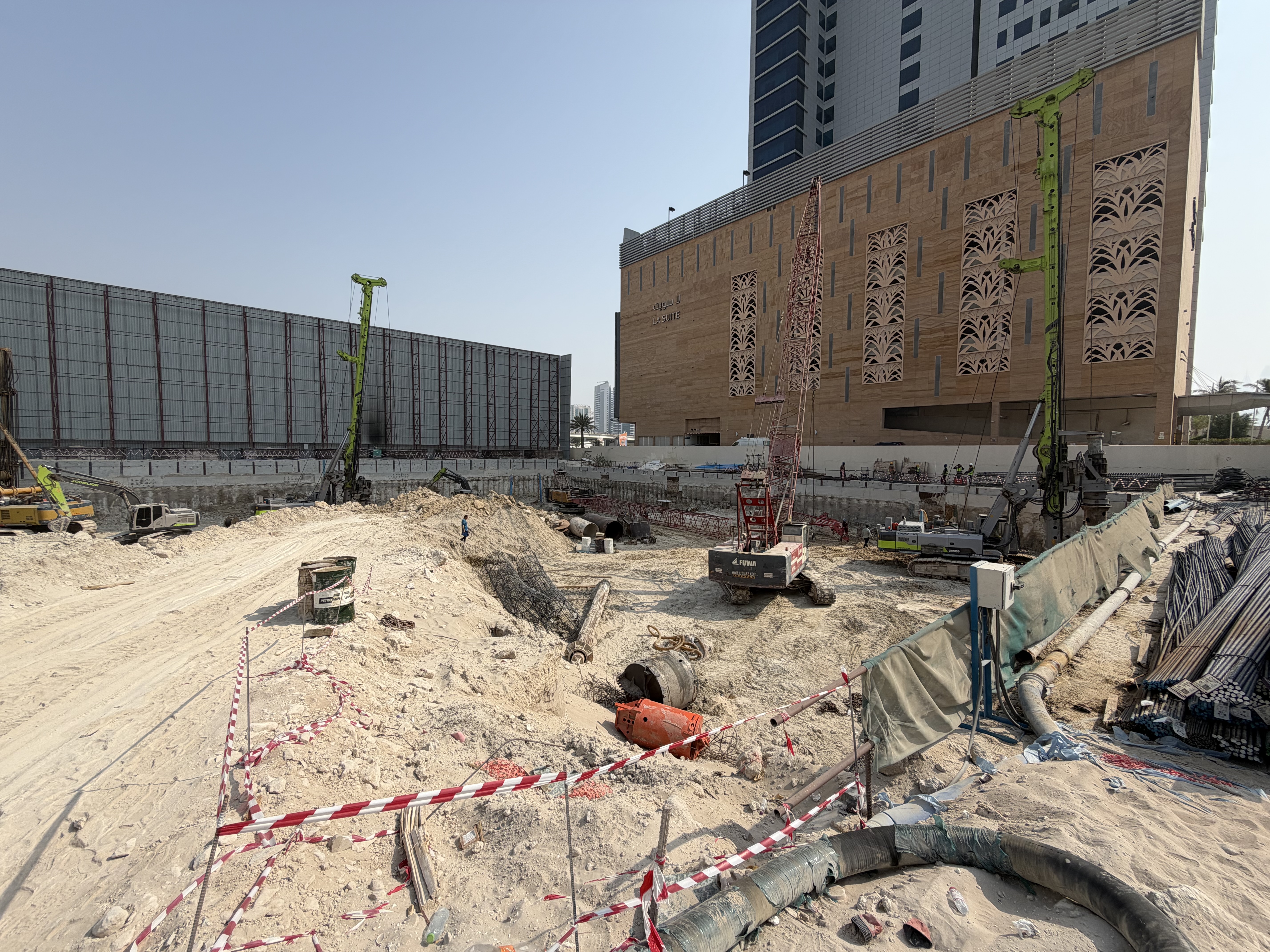

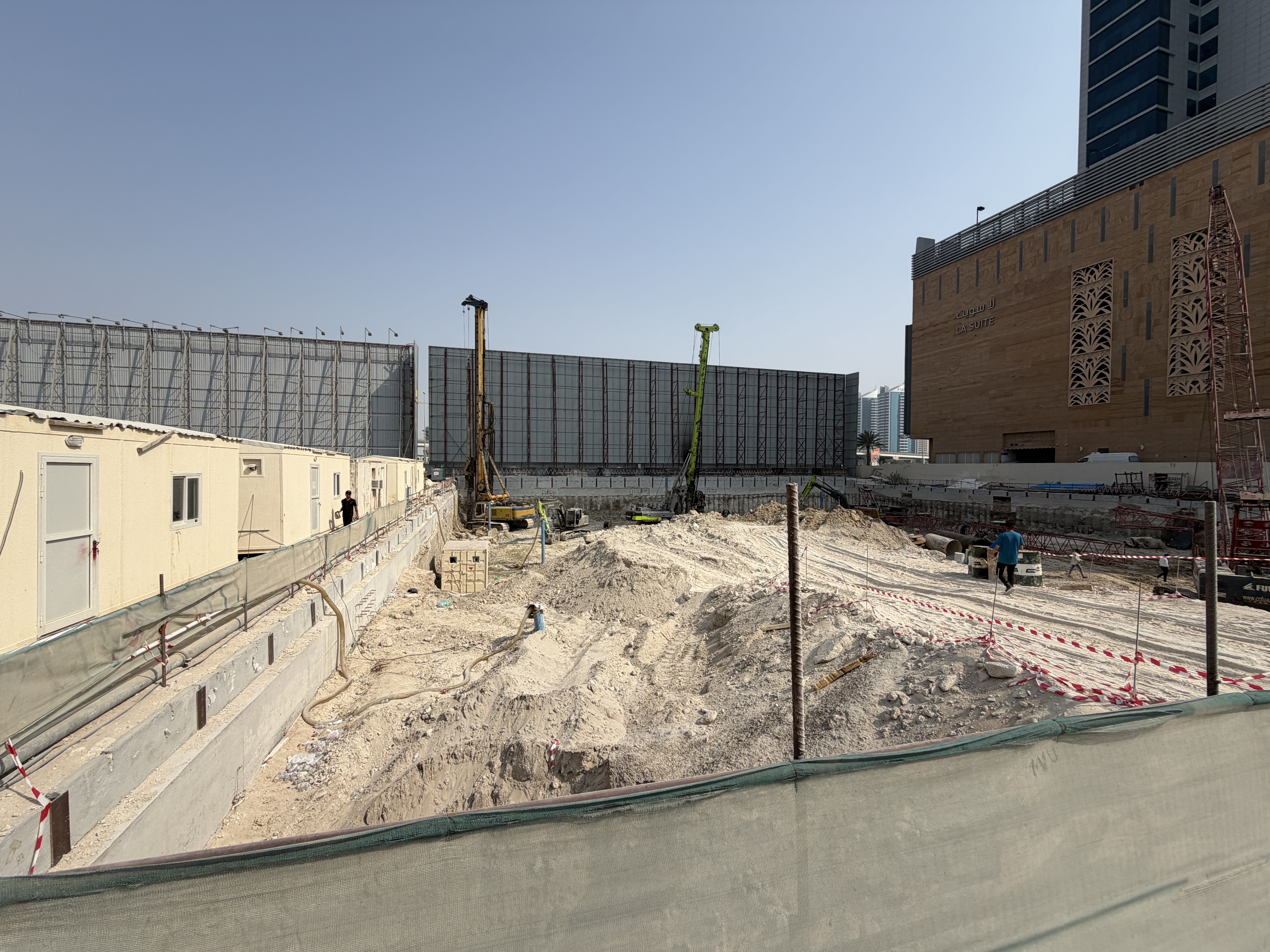

Construction photos — official DLD inspection uploads, newest first
Project facts
Registration & escrow — verify before you pay anyone
Under Law 8 of 2007, off-plan payments for this project belong only in the escrow account above — a developer or agent directing your money anywhere else is a serious red flag. How escrow protects you →
Location — official site coordinates from DLD inspection records
Al Safouh First · See every project on the construction map →
Shahrukhz by Danube: frequently asked questions — answers update daily from registry data
When will Shahrukhz by Danube be handed over?
How far along is construction on Shahrukhz by Danube?
Is Shahrukhz by Danube delayed?
Who is the developer of Shahrukhz by Danube, and do they deliver on time?
What are real sale prices in Shahrukhz by Danube?
Where is Shahrukhz by Danube located?
How many homes are in Shahrukhz by Danube?
Can I see real construction photos of Shahrukhz by Danube?
Is my money safe if I buy in Shahrukhz by Danube?
Where should payments for Shahrukhz by Danube go?
How do I get alerts when something changes on Shahrukhz by Danube?
Progress history — one row per official DLD snapshot
| Snapshot date | Status | Complete | Planned handover |
|---|---|---|---|
| 2026-08-04 | ACTIVE | 1.2% | 2029-06-30 |
| 2026-08-05 | ACTIVE | 1.2% | 2029-06-30 |
| 2026-08-06 | ACTIVE | 1.2% | 2029-06-30 |
| 2026-08-08 | ACTIVE | 1.2% | 2029-06-30 |
| 2026-08-09 | ACTIVE | 1.2% | 2029-06-30 |
| 2026-08-10 | ACTIVE | 1.2% | 2029-06-30 |
| 2026-08-11 | ACTIVE | 1.2% | 2029-06-30 |
| 2026-08-12 | ACTIVE | 1.2% | 2029-06-30 |
| 2026-08-13 | ACTIVE | 1.2% | 2029-06-30 |
| 2026-08-14 | ACTIVE | 1.2% | 2029-06-30 |
| 2026-08-15 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-16 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-17 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-18 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-19 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-20 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-21 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-22 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-23 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-24 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-25 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-26 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-27 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-28 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-29 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-30 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-08-31 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-01 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-02 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-03 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-04 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-05 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-06 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-07 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-08 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-09 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-10 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-11 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-12 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-13 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-14 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-15 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-16 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-17 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-18 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-19 | ACTIVE | 1.9% | 2029-06-30 |
| 2026-09-20 | ACTIVE | 1.9% | 2029-06-30 |
Change events
| Detected | Event | Change |
|---|---|---|
| 2026-08-15 | PROGRESS | 1.22 → 1.86 |
