The road to keys — registry facts, our forecast
How Samana South Haven 2 compares
Similar off-plan projects in Saih Shuaib 2 — compare progress, handover and developer.
Track this project
Get an email the moment DLD reports a change — construction progress, a status change, or a handover date that moves.
One click. Creates your free account — no password, ever.
Talk to a verified agent about Samana South Haven 2
Considering buying in Samana South Haven 2? Register your interest and we’ll connect you with a RERA-licensed Dubai agent who can walk you through availability, payment plans and resale value — alongside the honest, registry-backed data you see on this page. No obligation.
Building & unit mix — from DLD project records
| Usage | Unit type | Units |
|---|---|---|
| Residential | Studio | 48 |
| Residential | 1 B/R | 84 |
| Residential | 2 B/R | 5 |
Source: DLD project register — floors, buildings and the developer's registered unit mix.
Recent registered sales — individual DLD transactions, newest first
| Date | Beds | Size | Price | AED/sqft | Type |
|---|---|---|---|---|---|
| 2026-03-16 | — | 42,740 sqft | AED 6.8M | 158 | Resale |
| 2026-01-12 | — | 42,740 sqft | AED 14.5M | 339 | Resale |
Source: DLD registered sale transactions. Floor and unit numbers aren’t published in the public transaction feed, so they’re not shown.

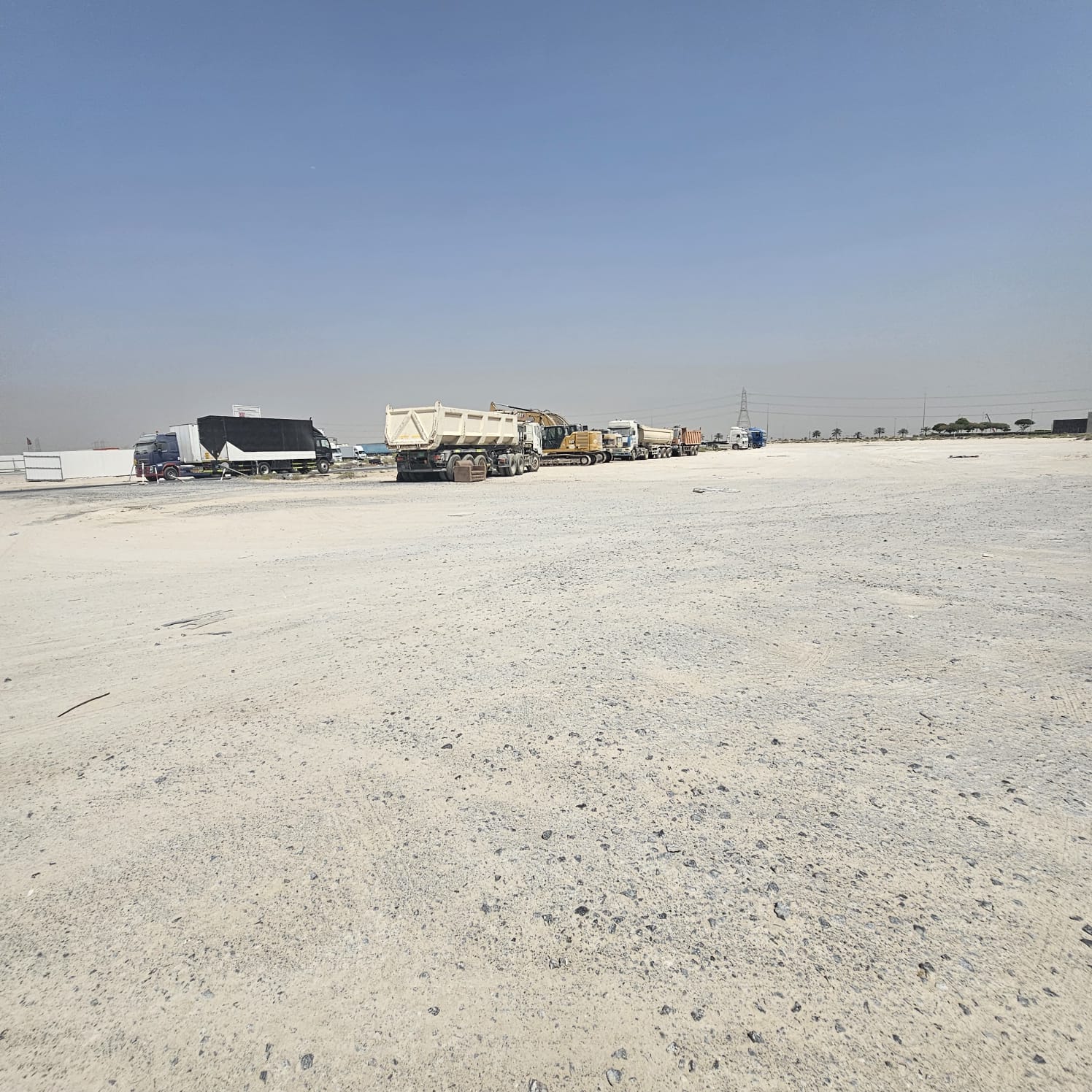

Construction photos — official DLD inspection uploads, newest first
Project facts
Registration & escrow — verify before you pay anyone
Under Law 8 of 2007, off-plan payments for this project belong only in the escrow account above — a developer or agent directing your money anywhere else is a serious red flag. How escrow protects you →
Location — official site coordinates from DLD inspection records
Saih Shuaib 2 · See every project on the construction map →
Samana South Haven 2: frequently asked questions — answers update daily from registry data
When will Samana South Haven 2 be handed over?
How far along is construction on Samana South Haven 2?
Is Samana South Haven 2 delayed?
Who is the developer of Samana South Haven 2, and do they deliver on time?
Where is Samana South Haven 2 located?
How many homes are in Samana South Haven 2?
Can I see real construction photos of Samana South Haven 2?
Is my money safe if I buy in Samana South Haven 2?
Where should payments for Samana South Haven 2 go?
How do I get alerts when something changes on Samana South Haven 2?
Progress history — one row per official DLD snapshot
| Snapshot date | Status | Complete | Planned handover |
|---|---|---|---|
| 2026-08-04 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-05 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-06 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-08 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-09 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-10 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-11 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-12 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-13 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-14 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-15 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-16 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-17 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-18 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-19 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-20 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-21 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-22 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-23 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-24 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-25 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-26 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-27 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-28 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-29 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-30 | PENDING | 0.0% | 2029-03-31 |
| 2026-08-31 | PENDING | 0.0% | 2029-03-31 |
| 2026-09-01 | PENDING | 0.0% | 2029-03-31 |
| 2026-09-02 | PENDING | 0.0% | 2029-03-31 |
| 2026-09-03 | PENDING | 0.0% | 2029-03-31 |
| 2026-09-04 | PENDING | 0.0% | 2029-03-31 |
| 2026-09-05 | PENDING | 0.0% | 2029-03-31 |
| 2026-09-06 | PENDING | 0.0% | 2029-03-31 |
| 2026-09-07 | PENDING | 0.0% | 2029-03-31 |
| 2026-09-08 | PENDING | 0.0% | 2029-03-31 |
| 2026-09-09 | PENDING | 0.0% | 2029-06-30 |
| 2026-09-10 | PENDING | 0.0% | 2029-06-30 |
| 2026-09-11 | ACTIVE | 0.0% | 2029-06-30 |
| 2026-09-12 | ACTIVE | 0.0% | 2029-06-30 |
| 2026-09-13 | ACTIVE | 0.0% | 2029-06-30 |
| 2026-09-14 | ACTIVE | 0.0% | 2029-06-30 |
| 2026-09-15 | ACTIVE | 0.0% | 2029-06-30 |
| 2026-09-16 | ACTIVE | 0.0% | 2029-06-30 |
| 2026-09-17 | ACTIVE | 0.0% | 2029-06-30 |
| 2026-09-18 | ACTIVE | 0.0% | 2029-06-30 |
| 2026-09-19 | ACTIVE | 0.0% | 2029-06-30 |
| 2026-09-20 | ACTIVE | 0.0% | 2029-06-30 |
Change events
| Detected | Event | Change |
|---|---|---|
| 2026-09-11 | STATUS_CHANGE | PENDING → ACTIVE |
| 2026-09-09 | HANDOVER_SLIP | 2029-03-31 → 2029-06-30 |
