Latest DLD inspection photo of Cavara Circle
Latest inspection · 2026-10-09 · DLD inspection
Planned handover2026-08-30
SourceDLD · daily

The road to keys — registry facts, our forecast

Registered start
2025-02-11
in the DLD registry
Today
51.5%
last inspected 2026-09-15
At the current pace
…
…
Planned handover
2026-08-30
58 days overdue — developer's official date

How Cavara Circle compares

Similar off-plan projects in Al Barsha South Fourth — compare progress, handover and developer.

Ready to take the next step?

Talk to a verified agent about Cavara Circle

Considering buying in Cavara Circle? Register your interest and we’ll connect you with a RERA-licensed Dubai agent who can walk you through availability, payment plans and resale value — alongside the honest, registry-backed data you see on this page. No obligation.

or register your interest below

By submitting, you agree to be contacted about this project. We only introduce currently RERA-licensed agents.

Watch it rise — one frame per DLD inspection

Cavara Circle on 2025-03-17
2025-03-17 · 0.0% complete
1 / 5

Building & unit mix — from DLD project records

7
Floors
71
Total units
1
Building
UsageUnit typeUnits
ResidentialStudio20
Residential1 B/R42
Residential2 B/R9

Source: DLD project register — floors, buildings and the developer's registered unit mix.

Sale price history — 25 sales, median AED/sqft by year

+2% median price growth from 2025 to 2026 · 88% of sales were off-plan

YearMedian AED/sqftSalesYear-on-yearSince launch
2025launch1,2505——
20261,26917+2%+2%

Median AED/sqft of DLD-registered sales each year (years with 3+ sales); the earliest year on record approximates launch pricing. “Year-on-year” compares each year to the one before it, “since launch” to the first year. Source: Dubai Land Department transaction records.

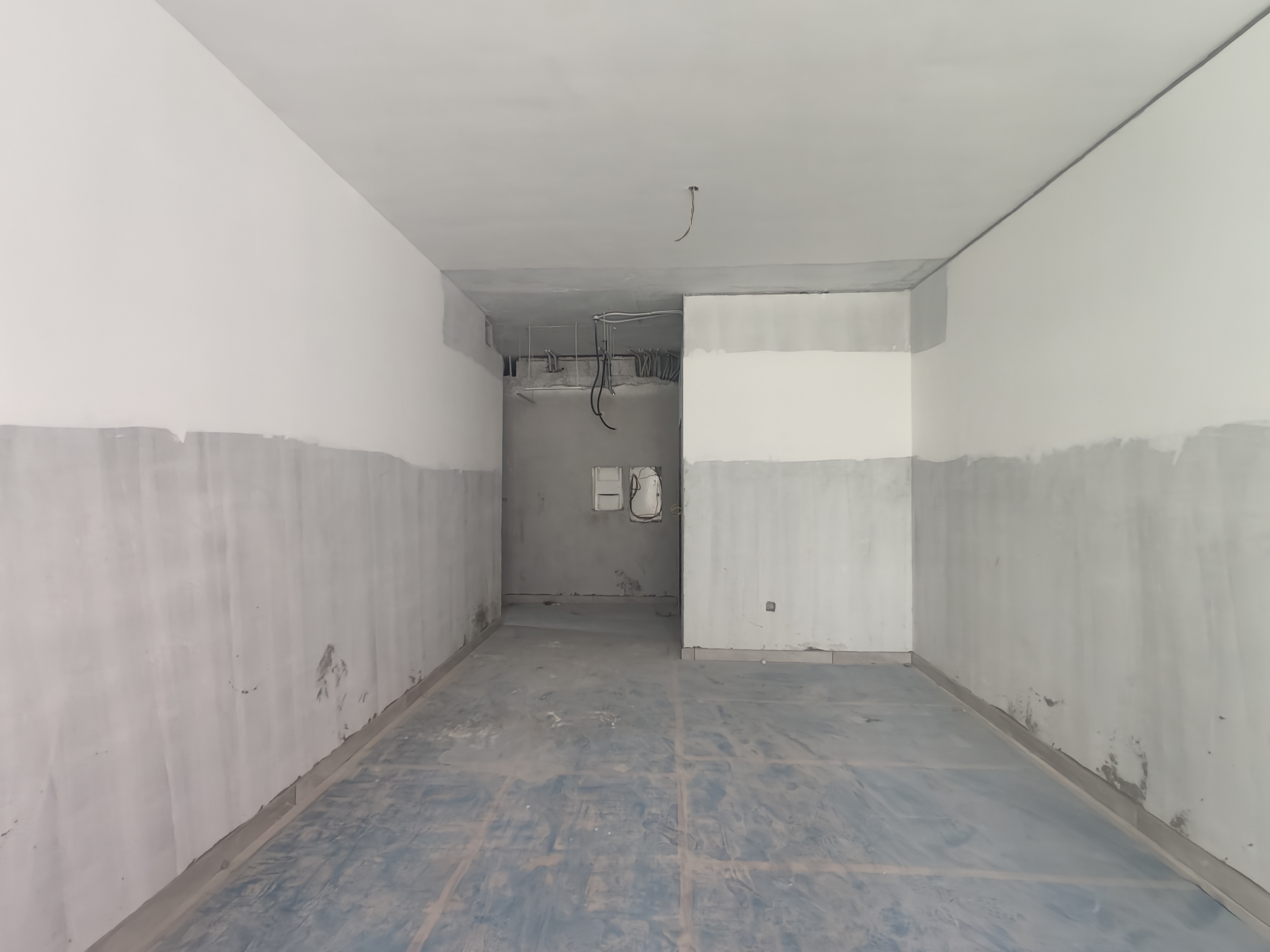

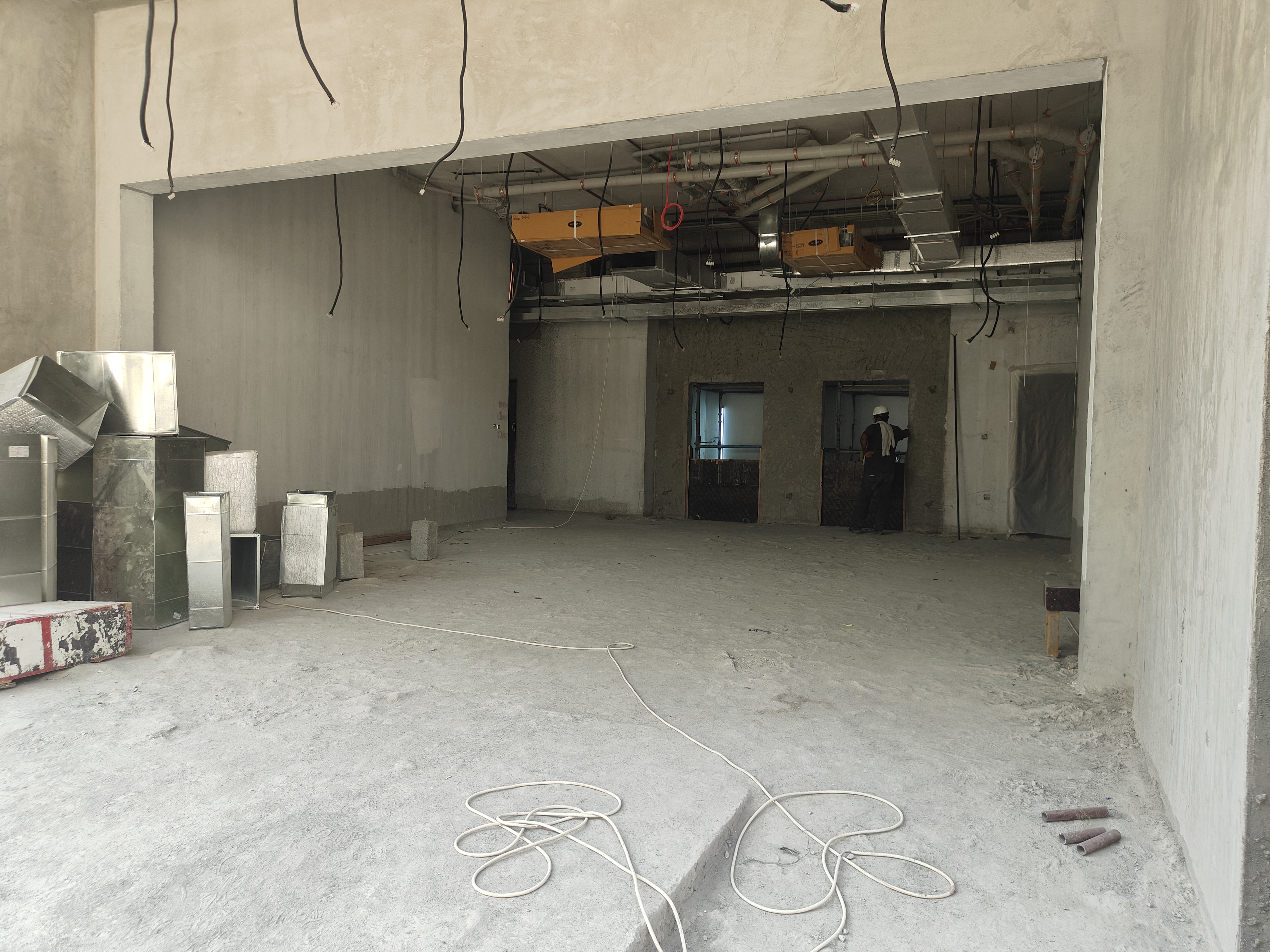

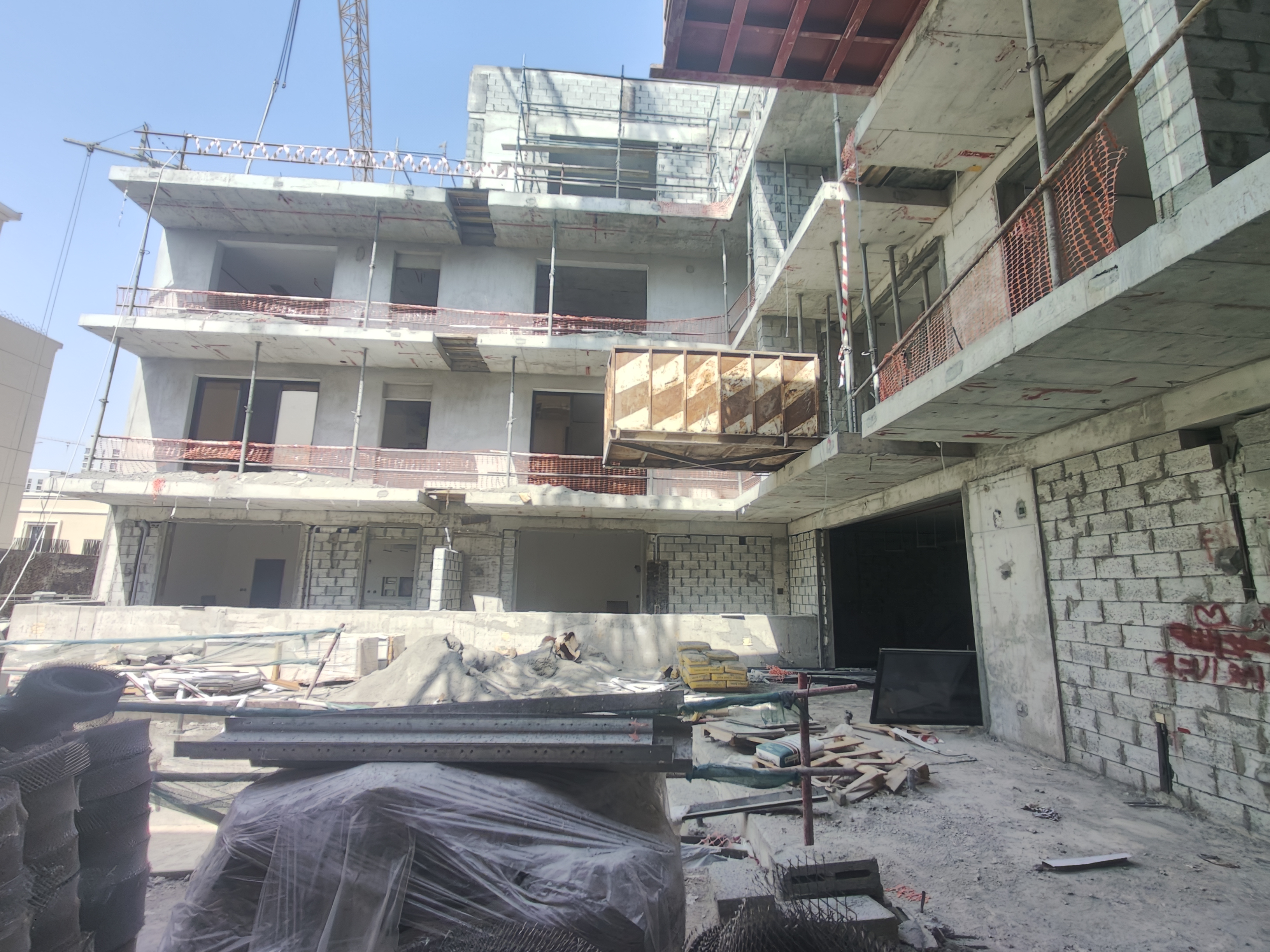

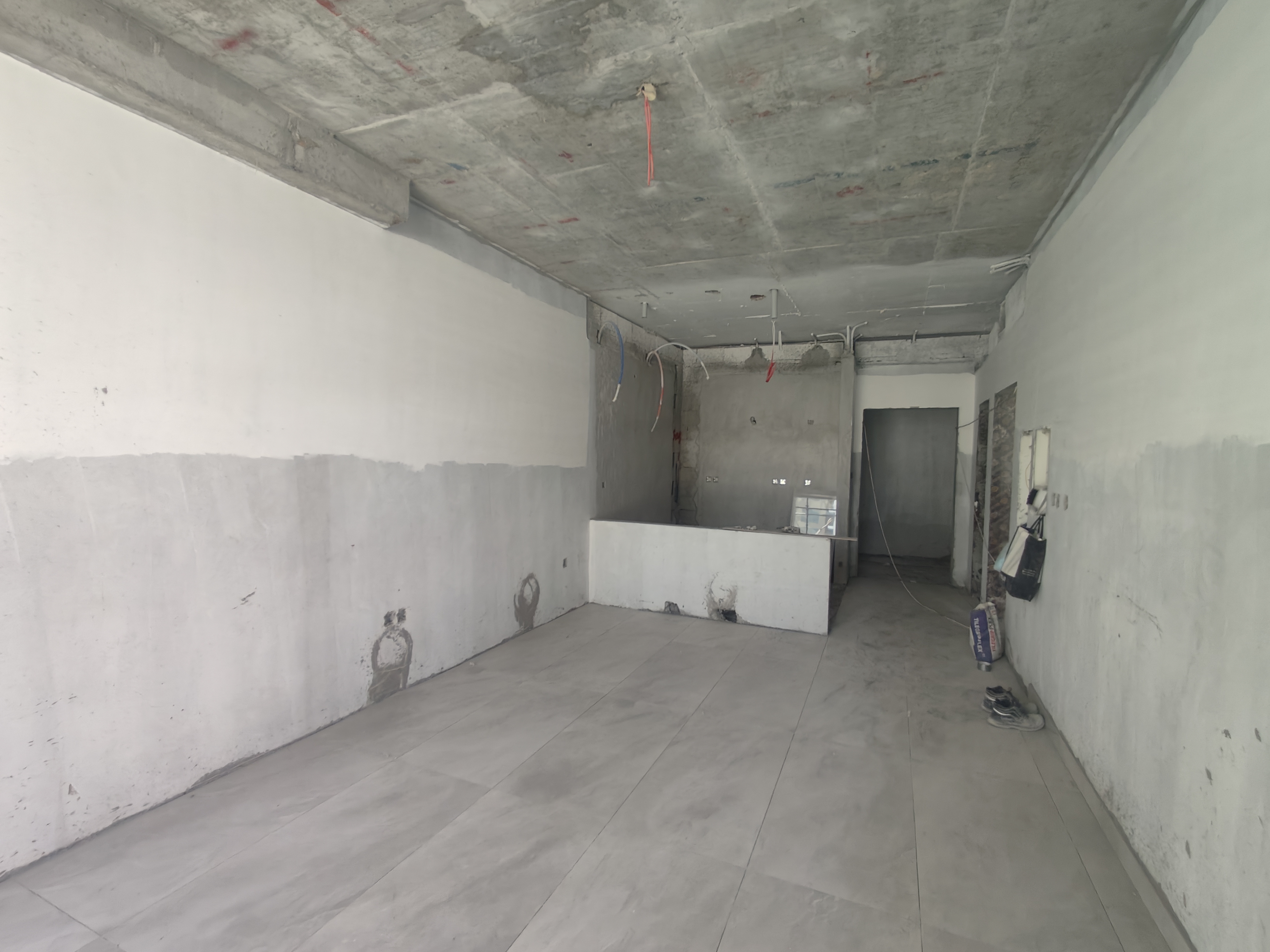

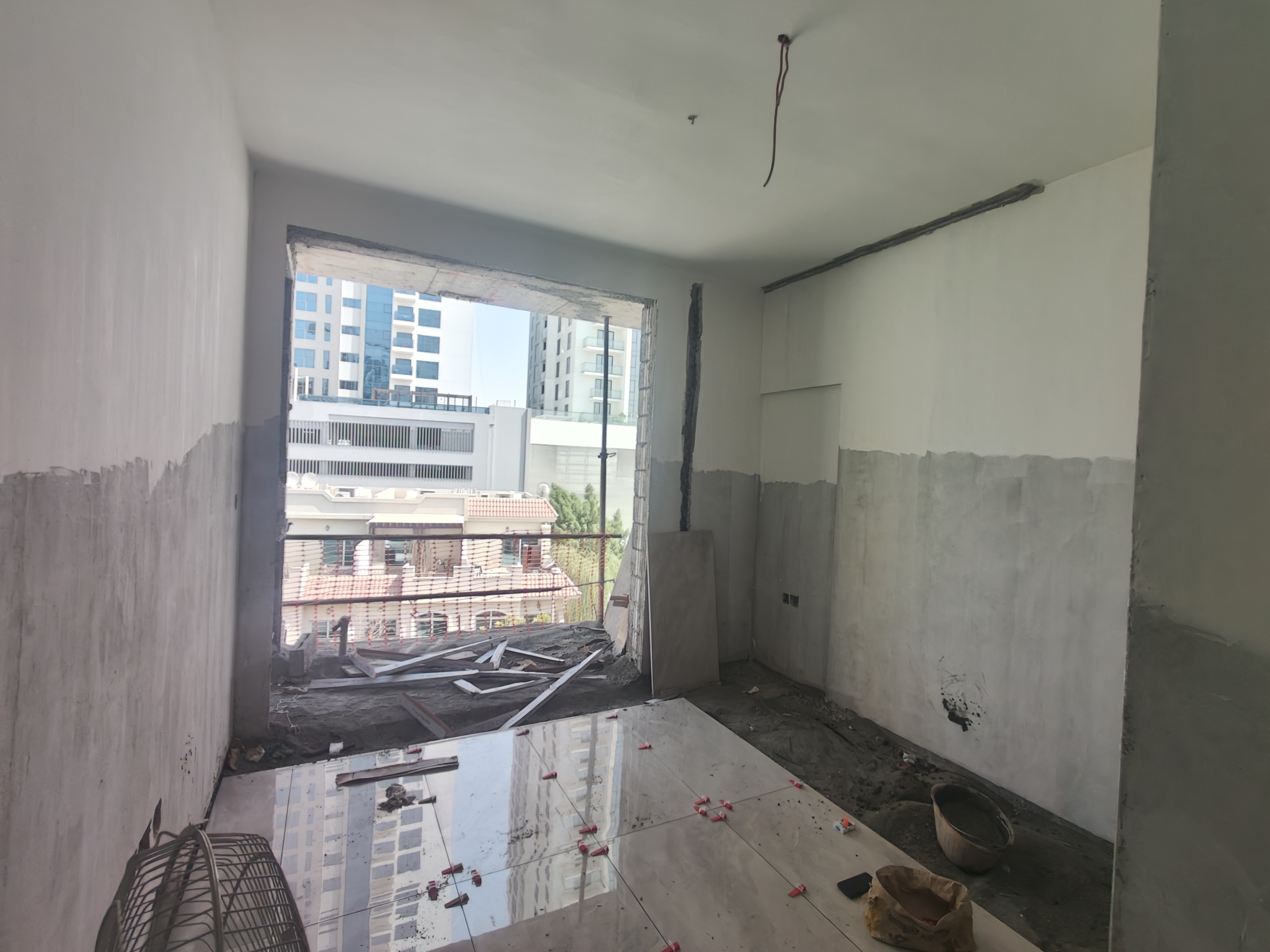

Construction photos — official DLD inspection uploads, newest first

Project facts

Developer
CAVARA REAL ESTATE DEVELOPMENT L.L.C
Area
Al Barsha South Fourth
Master project
—
Project type
Normal
Start date
2025-02-11
Planned handover
2026-08-30
Last inspection
2026-09-15
Project value
AED 36.5M
Units
71
Villas
0
Buildings
0
DLD project number
3624

Registration & escrow — verify before you pay anyone

DLD / RERA project no.
3624
Registered with DLD
2025-05-05
Regulator
Trakhees
Escrow account no.
0205915669007

Under Law 8 of 2007, off-plan payments for this project belong only in the escrow account above — a developer or agent directing your money anywhere else is a serious red flag. How escrow protects you →

Location — official site coordinates from DLD inspection records

Loading map…

Al Barsha South Fourth · See every project on the construction map →

Cavara Circle: frequently asked questions — answers update daily from registry data

When will Cavara Circle be handed over?
The developer's planned handover for Cavara Circle is 2026-08-30; construction is currently 51% complete. At the observed construction pace, our independent forecast is 2027-05-21.
How far along is construction on Cavara Circle?
Cavara Circle is 51.5% complete according to the Dubai Land Department's inspection of 2026-09-15.
Is Cavara Circle delayed?
Cavara Circle is 58 days past its planned handover of 2026-08-30 and still under construction. Most Dubai off-plan contracts include a grace period (often 6–12 months) beyond the anticipated date — see The Late List for how it compares.
Who is the developer of Cavara Circle, and do they deliver on time?
Cavara Circle is developed by CAVARA REAL ESTATE DEVELOPMENT L.L.C. On our Developer Reliability Index they score 58/100 (C — Slipping), based on how much of their active portfolio is past its planned handover in the official registry.
Where is Cavara Circle located?
Cavara Circle is located in Al Barsha South Fourth, Dubai. See every project in the area, plus prices and rents, on the area page.
How many homes are in Cavara Circle?
Cavara Circle comprises 71 units (normal), per the DLD registry.
Can I see real construction photos of Cavara Circle?
Yes — this page carries 28 official construction photos taken during Dubai Land Department inspections, newest from 2026-10-09, plus a time-lapse of the build. These are government inspection uploads, not marketing renders.
Is my money safe if I buy in Cavara Circle?
Payments for registered Dubai off-plan projects go into a project-specific escrow account under Law No. 8 of 2007; the developer can only draw funds against certified construction milestones.
Where should payments for Cavara Circle go?
Only into the project's DLD-registered escrow account (no. 0205915669007). Under Law 8 of 2007 every off-plan payment must go to this account, where the developer can only draw funds as construction milestones are certified. Anyone directing payments elsewhere is a serious warning sign.
How do I get alerts when something changes on Cavara Circle?
Use the free Track this project form on this page. We check the official registry every day and email you the moment Cavara Circle's progress, status, or planned handover date changes.

Progress history — one row per official DLD snapshot

Snapshot dateStatusCompletePlanned handover
2026-08-04ACTIVE31.8%2026-08-30
2026-08-05ACTIVE31.8%2026-08-30
2026-08-06ACTIVE31.8%2026-08-30
2026-08-08ACTIVE31.8%2026-08-30
2026-08-09ACTIVE31.8%2026-08-30
2026-08-10ACTIVE31.8%2026-08-30
2026-08-11ACTIVE31.8%2026-08-30
2026-08-12ACTIVE31.8%2026-08-30
2026-08-13ACTIVE31.8%2026-08-30
2026-08-14ACTIVE31.8%2026-08-30
2026-08-15ACTIVE31.8%2026-08-30
2026-08-16ACTIVE31.8%2026-08-30
2026-08-17ACTIVE31.8%2026-08-30
2026-08-18ACTIVE31.8%2026-08-30
2026-08-19ACTIVE31.8%2026-08-30
2026-08-20ACTIVE31.8%2026-08-30
2026-08-21ACTIVE31.8%2026-08-30
2026-08-22ACTIVE31.8%2026-08-30
2026-08-23ACTIVE31.8%2026-08-30
2026-08-24ACTIVE31.8%2026-08-30
2026-08-25ACTIVE31.8%2026-08-30
2026-08-26ACTIVE31.8%2026-08-30
2026-08-27ACTIVE31.8%2026-08-30
2026-08-28ACTIVE31.8%2026-08-30
2026-08-29ACTIVE31.8%2026-08-30
2026-08-30ACTIVE31.8%2026-08-30
2026-08-31ACTIVE31.8%2026-08-30
2026-09-01ACTIVE31.8%2026-08-30
2026-09-02ACTIVE31.8%2026-08-30
2026-09-03ACTIVE31.8%2026-08-30
2026-09-04ACTIVE31.8%2026-08-30
2026-09-05ACTIVE31.8%2026-08-30
2026-09-06ACTIVE31.8%2026-08-30
2026-09-07ACTIVE31.8%2026-08-30
2026-09-08ACTIVE31.8%2026-08-30
2026-09-09ACTIVE31.8%2026-08-30
2026-09-10ACTIVE31.8%2026-08-30
2026-09-11ACTIVE31.8%2026-08-30
2026-09-12ACTIVE31.8%2026-08-30
2026-09-13ACTIVE31.8%2026-08-30
2026-09-14ACTIVE31.8%2026-08-30
2026-09-15ACTIVE31.8%2026-08-30
2026-09-16ACTIVE31.8%2026-08-30
2026-09-17ACTIVE31.8%2026-08-30
2026-09-18ACTIVE31.8%2026-08-30
2026-09-19ACTIVE31.8%2026-08-30
2026-09-20ACTIVE31.8%2026-08-30
2026-09-21ACTIVE31.8%2026-08-30
2026-09-22ACTIVE31.8%2026-08-30
2026-09-23ACTIVE31.8%2026-08-30
2026-09-24ACTIVE31.8%2026-08-30
2026-09-25ACTIVE31.8%2026-08-30
2026-09-26ACTIVE31.8%2026-08-30
2026-09-27ACTIVE31.8%2026-08-30
2026-09-28ACTIVE31.8%2026-08-30
2026-09-29ACTIVE31.8%2026-08-30
2026-09-30ACTIVE31.8%2026-08-30
2026-10-01ACTIVE31.8%2026-08-30
2026-10-02ACTIVE31.8%2026-08-30
2026-10-03ACTIVE31.8%2026-08-30
2026-10-04ACTIVE31.8%2026-08-30
2026-10-05ACTIVE31.8%2026-08-30
2026-10-06ACTIVE31.8%2026-08-30
2026-10-07ACTIVE31.8%2026-08-30
2026-10-08ACTIVE31.8%2026-08-30
2026-10-09ACTIVE31.8%2026-08-30
2026-10-10ACTIVE31.8%2026-08-30
2026-10-11ACTIVE31.8%2026-08-30
2026-10-12ACTIVE31.8%2026-08-30
2026-10-13ACTIVE51.5%2026-08-30
2026-10-14ACTIVE51.5%2026-08-30
2026-10-15ACTIVE51.5%2026-08-30
2026-10-16ACTIVE51.5%2026-08-30
2026-10-17ACTIVE51.5%2026-08-30
2026-10-18ACTIVE51.5%2026-08-30
2026-10-19ACTIVE51.5%2026-08-30
2026-10-20ACTIVE51.5%2026-08-30
2026-10-21ACTIVE51.5%2026-08-30
2026-10-22ACTIVE51.5%2026-08-30
2026-10-23ACTIVE51.5%2026-08-30
2026-10-24ACTIVE51.5%2026-08-30
2026-10-25ACTIVE51.5%2026-08-30
2026-10-26ACTIVE51.5%2026-08-30
2026-10-27ACTIVE51.5%2026-08-30

Change events

DetectedEventChange
2026-10-13PROGRESS31.76 → 51.46
Don't check back — we'll tell you.Progress moves, dates slip, statuses change. One email the moment it happens.
