Home / Projects / THE EIGHTY THREE

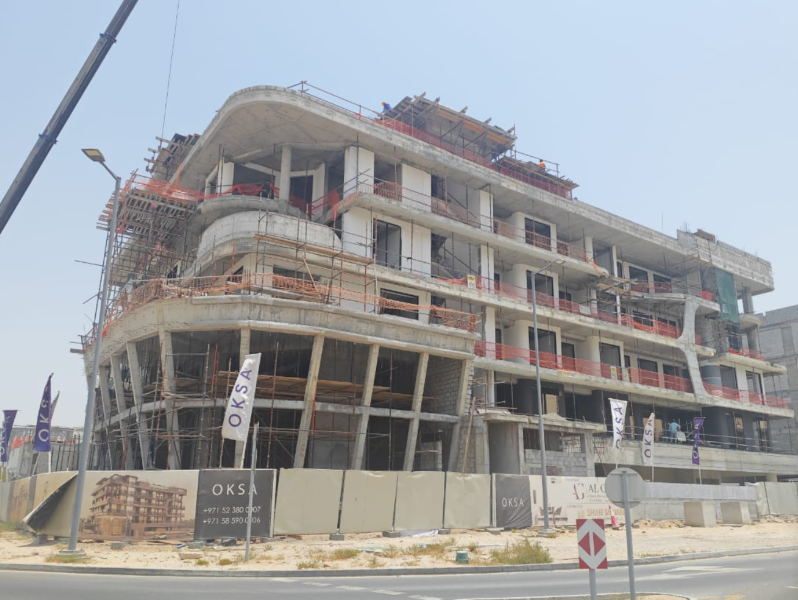

Latest DLD inspection photo of THE EIGHTY THREE
Latest inspection · 2026-08-11 · DLD inspection
Planned handover2026-12-14
SourceDLD · daily

The road to keys — registry facts, our forecast

Registered start
2024-11-14
in the DLD registry
Today
60.0%
last inspected 2026-08-06
At the current pace
Planned handover
2026-12-14
developer's official date

Investor snapshot — estimated yield

6.2%estimated gross rental yield

1,329/sqft median sale price (this project)

82/sqft/yr median rent in Madinat Al Mataar

Estimate: area-wide median rent ÷ this project’s median sale price, from Dubai Land Department records. Actual rent varies by unit, floor and finish.

How THE EIGHTY THREE compares

Similar off-plan projects in Madinat Al Mataar — compare progress, handover and developer.

Ready to take the next step?

Talk to a verified agent about THE EIGHTY THREE

Considering buying in THE EIGHTY THREE? Register your interest and we’ll connect you with a RERA-licensed Dubai agent who can walk you through availability, payment plans and resale value — alongside the honest, registry-backed data you see on this page. No obligation.

or register your interest below

By submitting, you agree to be contacted about this project. We only introduce currently RERA-licensed agents.

Watch it rise — one frame per DLD inspection

THE EIGHTY THREE on 2024-09-04
2024-09-04 · 0.0% complete
1 / 6

Building & unit mix — from DLD project records

6
Floors
70
Total units
1
Building
UsageUnit typeUnits
ResidentialStudio24
Residential1 B/R14
Residential2 B/R32

Source: DLD project register — floors, buildings and the developer's registered unit mix.

Real sale prices 11 registered DLD sales since 2026-01-06

AED 1,329/sqft
Median sale price
11
Registered sales
11
Sales, last 12 months
Unit typeSalesMedian AED/sqftMedian price
Studio51,559AED 585,000
2 B/R41,207AED 1.3M
1 B/R21,324AED 902,500

Source: DLD registered sale transactions for this project.

Prices by unit size — vs the Madinat Al Mataar average

BedsUnits soldSize rangeMedian priceAED/sqftArea avgPremium vs area
Studio5369382 sqftAED 585,0001,5591,780-12%
1 B/R2681682 sqftAED 902,5001,3241,610-18%
2 B/R49001,296 sqftAED 1.3M1,2071,604-25%

Median AED/sqft of DLD-registered sales in this project vs all sales in Madinat Al Mataar for the same unit type. “Premium vs area” is how much more (or less) buyers pay here than the neighbourhood average.

Sale price history 50 sales, median AED/sqft by year

+5% median price growth from 2025 to 2026 · 96% of sales were off-plan

YearMedian AED/sqftSalesYear-on-yearSince launch
2025launch1,27836
20261,34212+5%+5%

Median AED/sqft of DLD-registered sales each year (years with 3+ sales); the earliest year on record approximates launch pricing. “Year-on-year” compares each year to the one before it, “since launch” to the first year. Source: Dubai Land Department transaction records.

Available layouts — check current availability & price

Layouts registered in THE EIGHTY THREE, grouped by size. We’ll confirm current availability, floor and price with a RERA-licensed agent — we don’t hold live developer inventory, so these are representative configurations, not a live unit list.

BedsSizeTypical priceAED/sqftRegistered
Studio370 sqftAED 585K1,5595
1 B/R682 sqftAED 903K1,3242
2 B/R900 sqftAED 1.1M1,2221
2 B/R1,166 sqftAED 1.4M1,2072
2 B/R1,296 sqftAED 1.2M8991

Recent registered sales — individual DLD transactions, newest first

DateBedsSizePriceAED/sqftType
2026-06-221 B/R682 sqftAED 900,0001,319Off-plan
2026-05-18Studio369 sqftAED 585,0001,587Off-plan
2026-04-152 B/R1,164 sqftAED 1.4M1,215Off-plan
2026-03-16Studio370 sqftAED 501,5001,356Off-plan
2026-03-10Studio370 sqftAED 586,0001,584Off-plan
2026-02-14Studio382 sqftAED 595,0001,559Off-plan
2026-02-042 B/R1,167 sqftAED 1.4M1,199Off-plan
2026-02-032 B/R900 sqftAED 1.1M1,222Off-plan
2026-01-23Studio377 sqftAED 540,5001,432Off-plan
2026-01-232 B/R1,296 sqftAED 1.2M899Off-plan
2026-01-061 B/R681 sqftAED 905,0001,329Off-plan

Source: DLD registered sale transactions. Floor and unit numbers aren’t published in the public transaction feed, so they’re not shown.

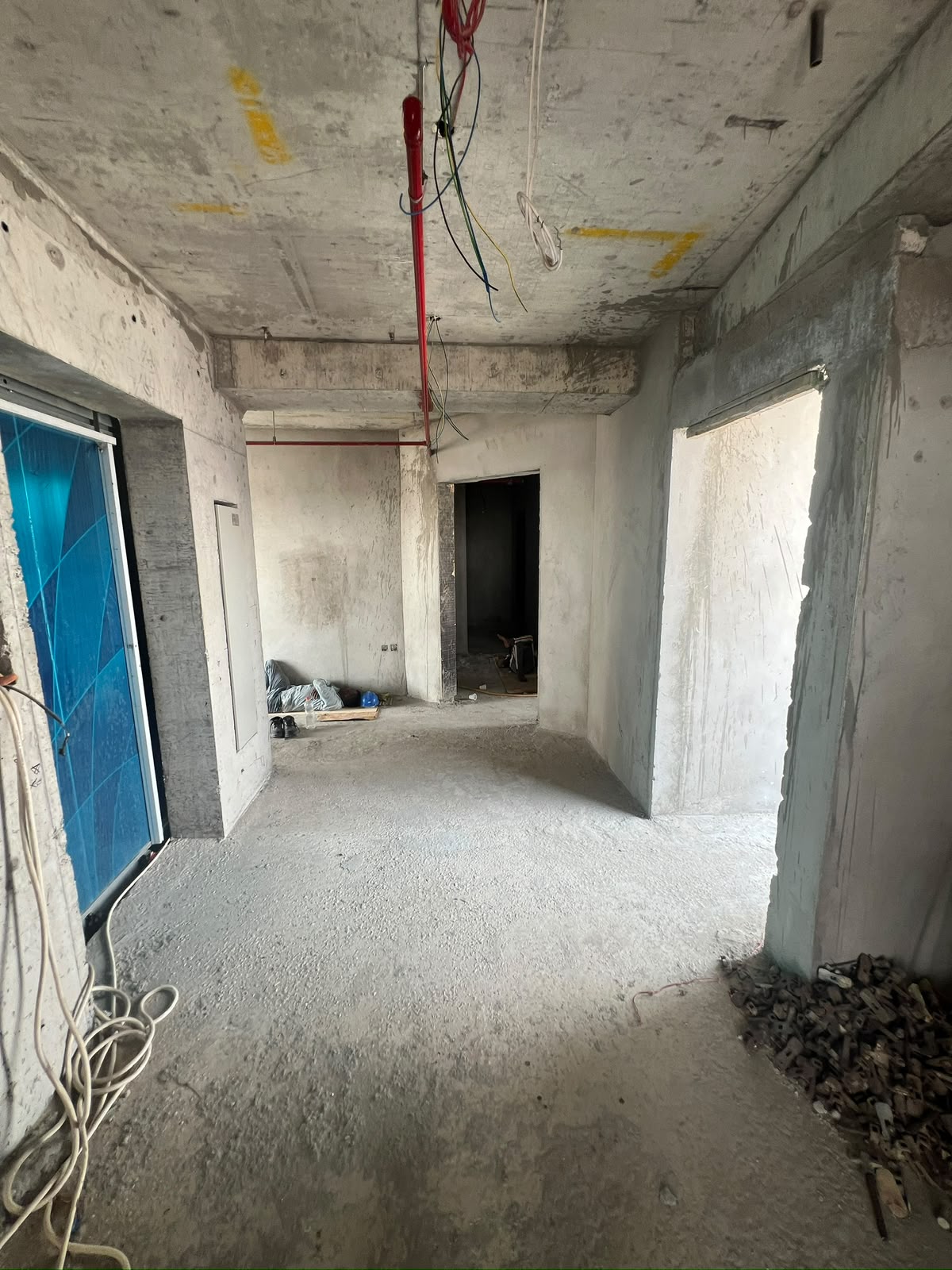

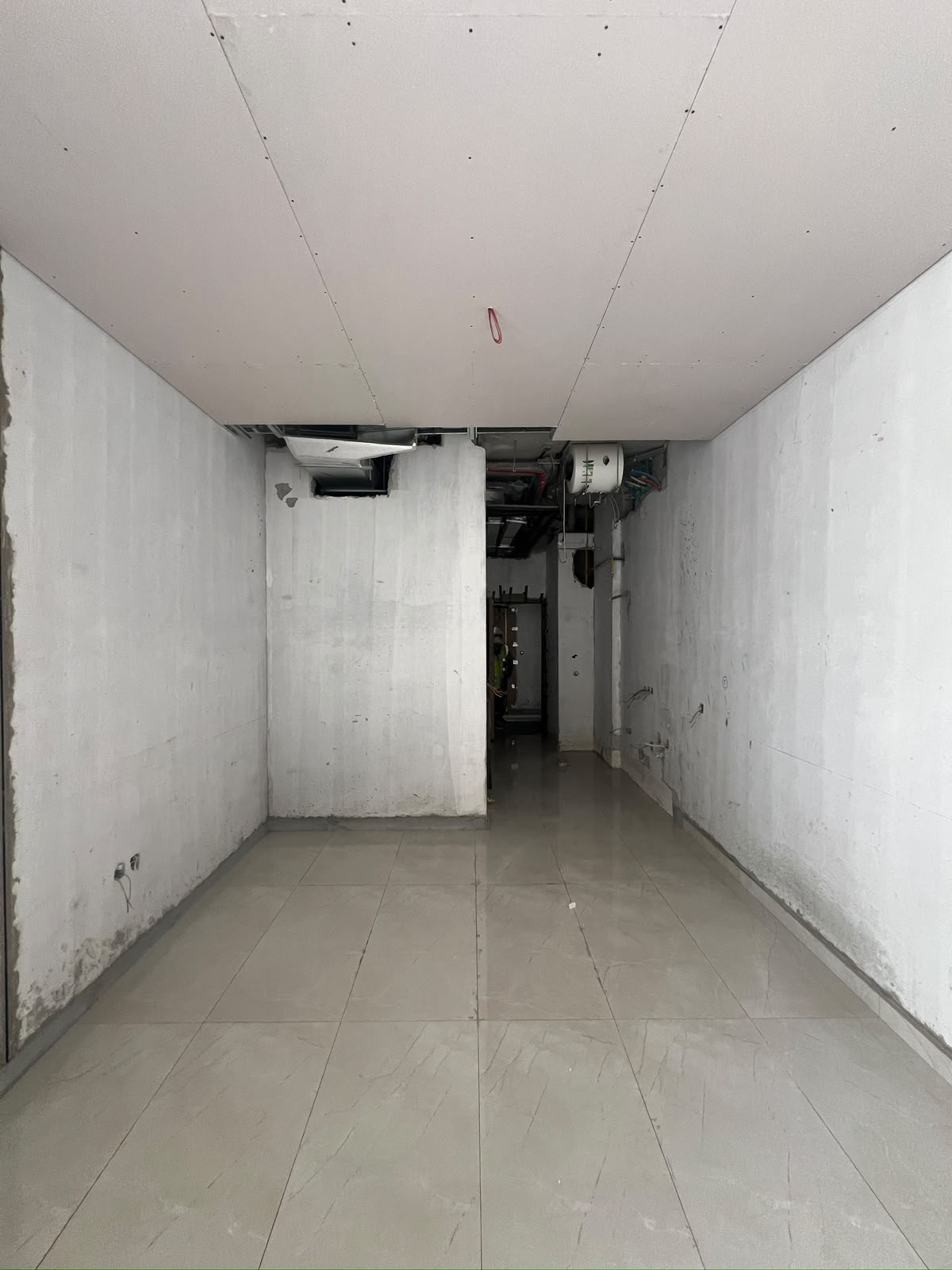

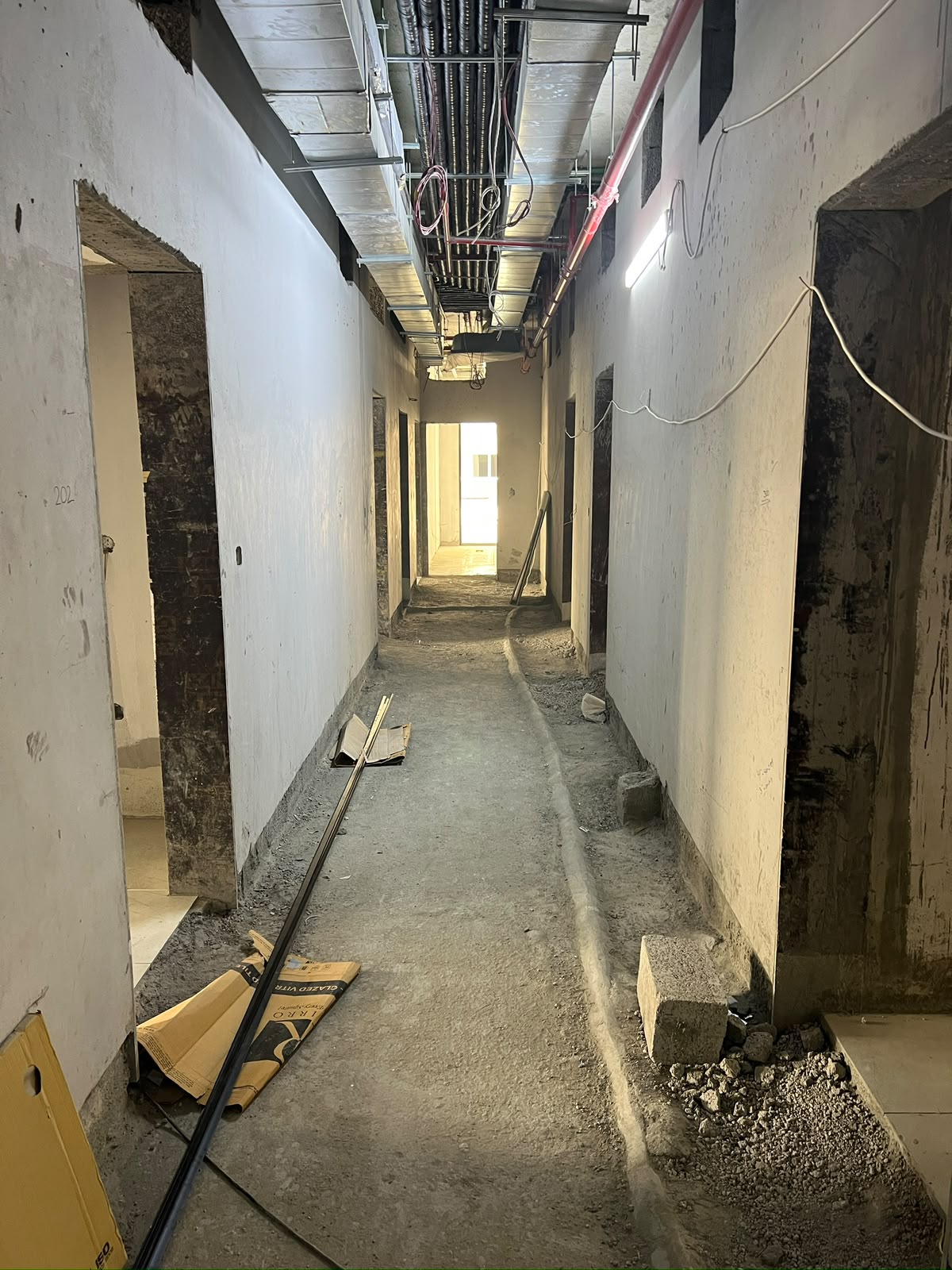

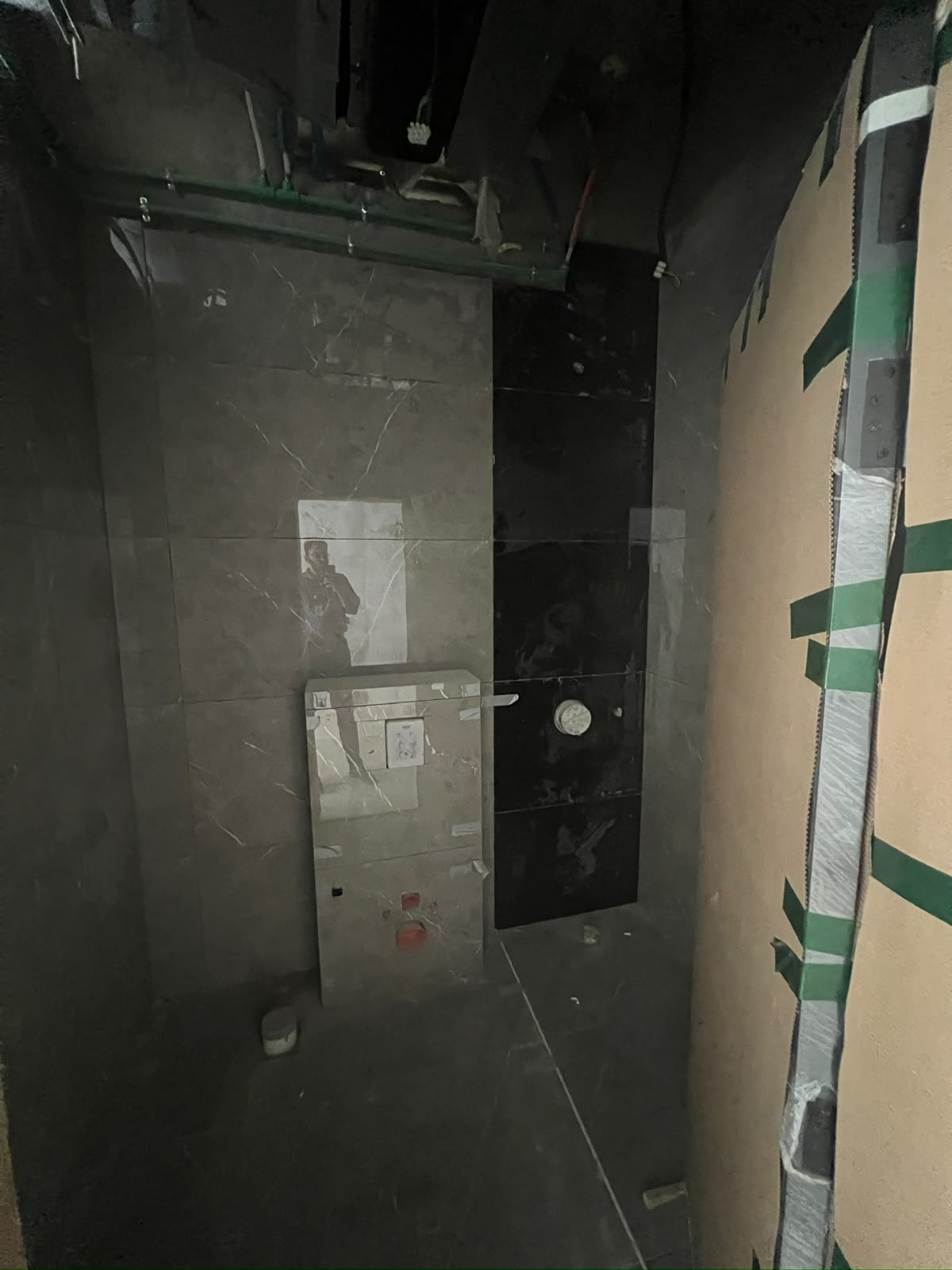

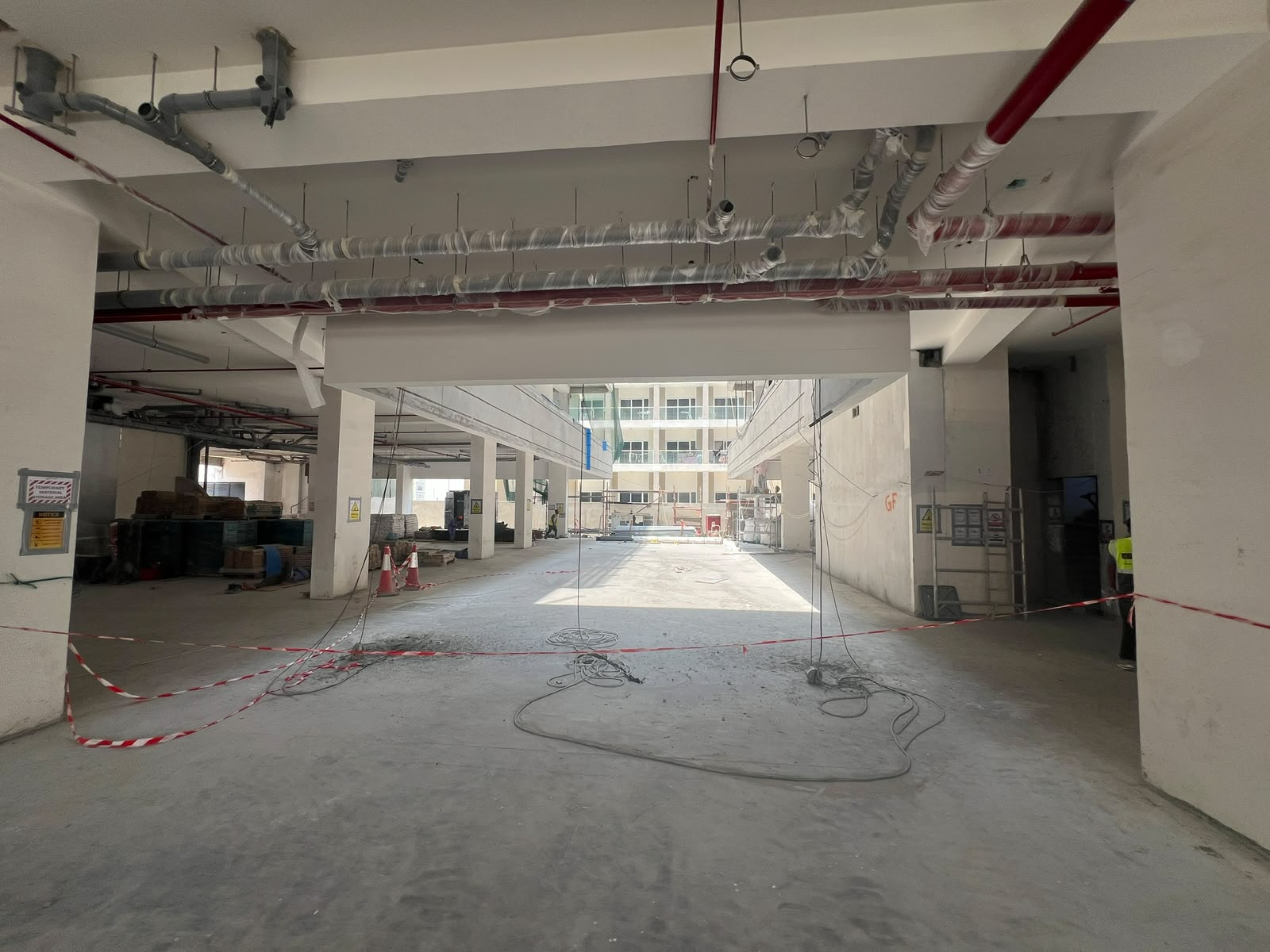

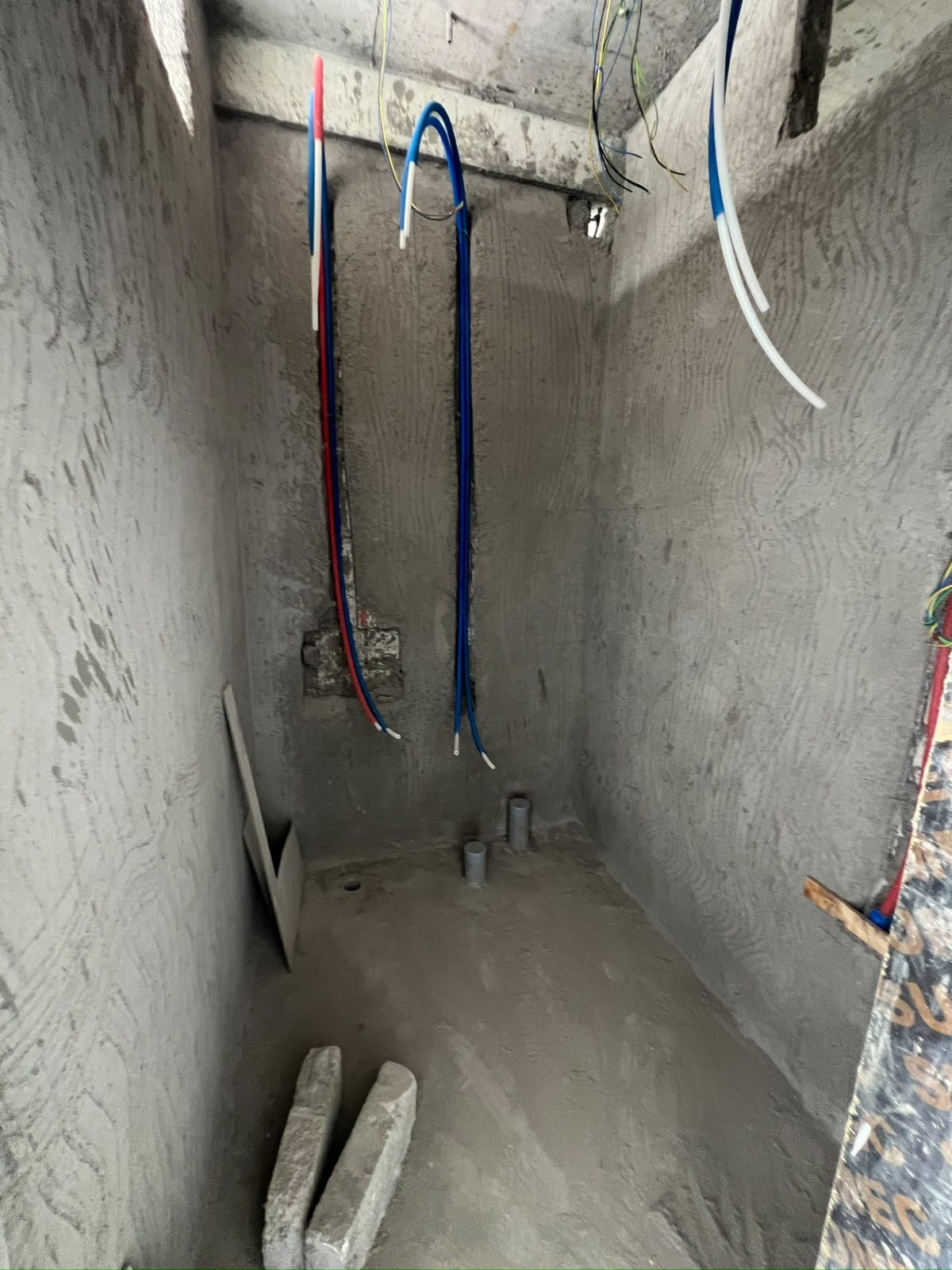

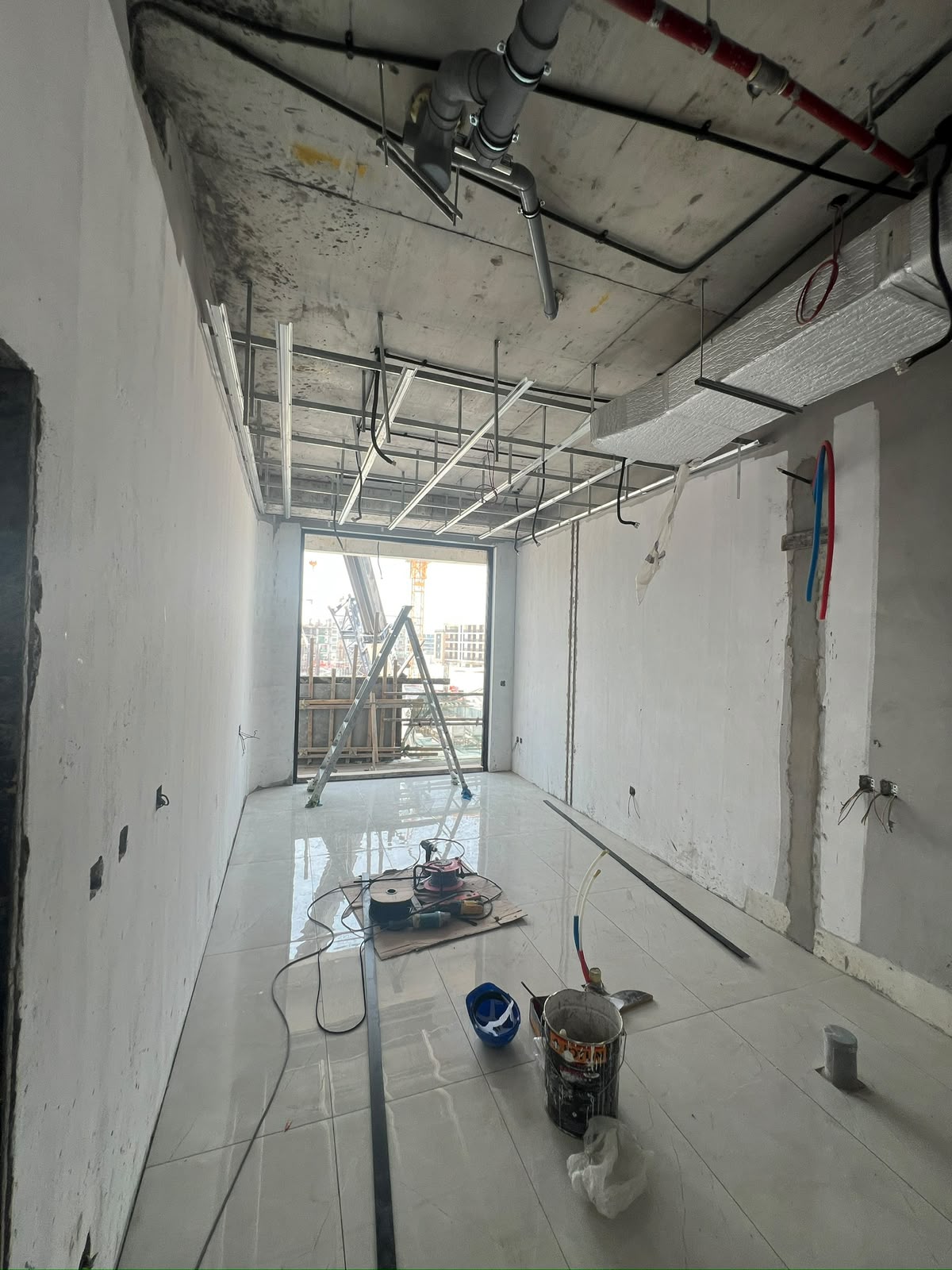

Construction photos — official DLD inspection uploads, newest first

Project facts

Developer
OKSA DEVELOPER L.L.C
Area
Madinat Al Mataar
Master project
Project type
Normal
Start date
2024-11-14
Planned handover
2026-12-14
Last inspection
2026-08-06
Project value
AED 19.0M
Units
70
Villas
0
Buildings
0
DLD project number
3270

Registration & escrow — verify before you pay anyone

DLD / RERA project no.
3270
Registered with DLD
2024-11-28
Regulator
Dubai South
Escrow account no.
9419226126887005

Under Law 8 of 2007, off-plan payments for this project belong only in the escrow account above — a developer or agent directing your money anywhere else is a serious red flag. How escrow protects you →

Location — official site coordinates from DLD inspection records

Loading map…

Madinat Al Mataar · See every project on the construction map →

THE EIGHTY THREE: frequently asked questions — answers update daily from registry data

When will THE EIGHTY THREE be handed over?
The developer's planned handover for THE EIGHTY THREE is 2026-12-14; construction is currently 60% complete. At the observed construction pace, our independent forecast is 2027-04-05.
How far along is construction on THE EIGHTY THREE?
THE EIGHTY THREE is 60.0% complete according to the Dubai Land Department's inspection of 2026-08-06.
Is THE EIGHTY THREE delayed?
As of today, THE EIGHTY THREE has not passed its planned handover date of 2026-12-14. We compare the official date against the calendar daily and record every change on this page.
Who is the developer of THE EIGHTY THREE, and do they deliver on time?
THE EIGHTY THREE is developed by OKSA DEVELOPER L.L.C. On our Developer Reliability Index they score 89/100 (A On schedule), based on how much of their active portfolio is past its planned handover in the official registry.
What are real sale prices in THE EIGHTY THREE?
Registered DLD sales in THE EIGHTY THREE show a median of AED 1,329/sqft across 11 transactions since 2026-01-06. These are actual registered sales, not asking prices — the full breakdown is on this page.
Where is THE EIGHTY THREE located?
THE EIGHTY THREE is located in Madinat Al Mataar, Dubai. See every project in the area, plus prices and rents, on the area page.
How many homes are in THE EIGHTY THREE?
THE EIGHTY THREE comprises 70 units (normal), per the DLD registry.
Can I see real construction photos of THE EIGHTY THREE?
Yes — this page carries 41 official construction photos taken during Dubai Land Department inspections, newest from 2026-08-11, plus a time-lapse of the build. These are government inspection uploads, not marketing renders.
Is my money safe if I buy in THE EIGHTY THREE?
Payments for registered Dubai off-plan projects go into a project-specific escrow account under Law No. 8 of 2007; the developer can only draw funds against certified construction milestones.
Where should payments for THE EIGHTY THREE go?
Only into the project's DLD-registered escrow account (no. 9419226126887005). Under Law 8 of 2007 every off-plan payment must go to this account, where the developer can only draw funds as construction milestones are certified. Anyone directing payments elsewhere is a serious warning sign.
How do I get alerts when something changes on THE EIGHTY THREE?
Use the free Track this project form on this page. We check the official registry every day and email you the moment THE EIGHTY THREE's progress, status, or planned handover date changes.

Progress history — one row per official DLD snapshot

Snapshot dateStatusCompletePlanned handover
2026-08-04ACTIVE50.3%2026-12-14
2026-08-05ACTIVE50.3%2026-12-14
2026-08-06ACTIVE50.3%2026-12-14
2026-08-08ACTIVE50.3%2026-12-14
2026-08-09ACTIVE50.3%2026-12-14
2026-08-10ACTIVE50.3%2026-12-14
2026-08-11ACTIVE50.3%2026-12-14
2026-08-12ACTIVE50.3%2026-12-14
2026-08-13ACTIVE60.0%2026-12-14
2026-08-14ACTIVE60.0%2026-12-14
2026-08-15ACTIVE60.0%2026-12-14
2026-08-16ACTIVE60.0%2026-12-14
2026-08-17ACTIVE60.0%2026-12-14
2026-08-18ACTIVE60.0%2026-12-14
2026-08-19ACTIVE60.0%2026-12-14
2026-08-20ACTIVE60.0%2026-12-14
2026-08-21ACTIVE60.0%2026-12-14
2026-08-22ACTIVE60.0%2026-12-14
2026-08-23ACTIVE60.0%2026-12-14
2026-08-24ACTIVE60.0%2026-12-14
2026-08-25ACTIVE60.0%2026-12-14
2026-08-26ACTIVE60.0%2026-12-14
2026-08-27ACTIVE60.0%2026-12-14
2026-08-28ACTIVE60.0%2026-12-14
2026-08-29ACTIVE60.0%2026-12-14
2026-08-30ACTIVE60.0%2026-12-14
2026-08-31ACTIVE60.0%2026-12-14
2026-09-01ACTIVE60.0%2026-12-14
2026-09-02ACTIVE60.0%2026-12-14
2026-09-03ACTIVE60.0%2026-12-14
2026-09-04ACTIVE60.0%2026-12-14
2026-09-05ACTIVE60.0%2026-12-14
2026-09-06ACTIVE60.0%2026-12-14
2026-09-07ACTIVE60.0%2026-12-14
2026-09-08ACTIVE60.0%2026-12-14
2026-09-09ACTIVE60.0%2026-12-14
2026-09-10ACTIVE60.0%2026-12-14
2026-09-11ACTIVE60.0%2026-12-14
2026-09-12ACTIVE60.0%2026-12-14
2026-09-13ACTIVE60.0%2026-12-14
2026-09-14ACTIVE60.0%2026-12-14
2026-09-15ACTIVE60.0%2026-12-14
2026-09-16ACTIVE60.0%2026-12-14
2026-09-17ACTIVE60.0%2026-12-14
2026-09-18ACTIVE60.0%2026-12-14
2026-09-19ACTIVE60.0%2026-12-14
2026-09-20ACTIVE60.0%2026-12-14
2026-09-21ACTIVE60.0%2026-12-14

Change events

DetectedEventChange
2026-08-13PROGRESS50.2960.03
Don't check back — we'll tell you.Progress moves, dates slip, statuses change. One email the moment it happens.
Track THE EIGHTY THREE
